Skip to main content

Active Projects

photos coming soon

Commenced August 2026

Alcatraz Avenue and Santa Rosa Avenue Pipeline Replacement Project

Estimated Project Cost: $400,000
LEARN MORE

This project will replace all existing domestic water lines on Alcatraz and Santa Rosa Avenue in the Miramar neighborhood. The work includes the installation of approximately 660 feet of 6-inch ductile iron pipe (DIP), new gate valves, and new water service connections.

The project will relocate several service lines away from the ocean bluffs, reducing the risk of damage from erosion and improving long-term system reliability. It will also enhance the District’s ability to isolate sections of the water distribution system during maintenance or emergency repairs. In addition, the project will remove an existing water line located in an easement through residential properties that is difficult to access for maintenance.

This area has experienced several water line leaks in recent years, and replacing the aging infrastructure will improve system reliability, reduce future maintenance needs, and enhance operational efficiency.

Commenced January 2026

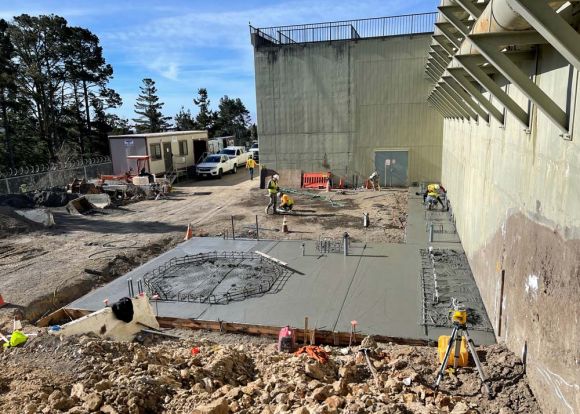

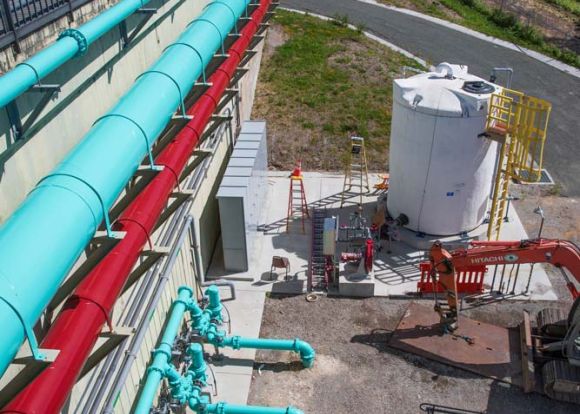

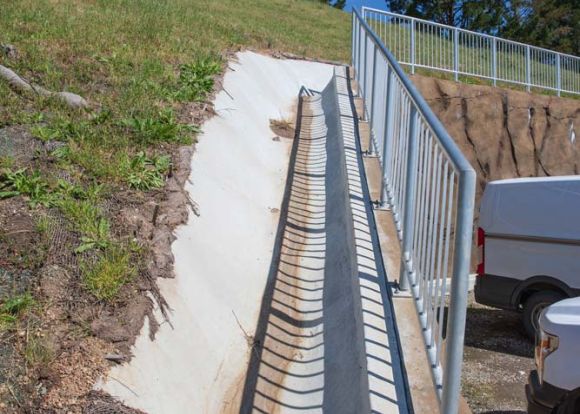

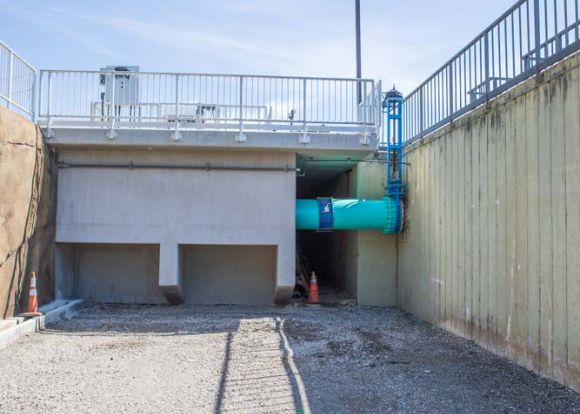

Pilarcitos Wellfield Replacement Project

Estimated Project Cost: $4,200,000
Estimated completion Fall 2026
LEARN MORE

The District has six shallow raw water wells under the influence of surface water located in Pilarcitos Canyon that serve as the points of diversion for the District’s surface water rights to Pilarcitos Creek (License for Diversion and Use of Water No. 10598.) Pumping is limited to November 1 through March 31, and the maximum annual diversion volume is 360 acre-feet per year. The District has maximized this water right since the 1960’s, supplying approximately 20% of the District’s current annual water demands.

Three of the wells were built in the 1960’s; two in the 1970’s; and one in the 1990’s. The condition of these aging wells present operational challenges and increasingly high maintenance costs due to scale buildup, fouling, and corrosion that requires frequent and costly cleaning and pump maintenance. In addition, the existing wells lack modern automation and monitoring capabilities and require manual operation.

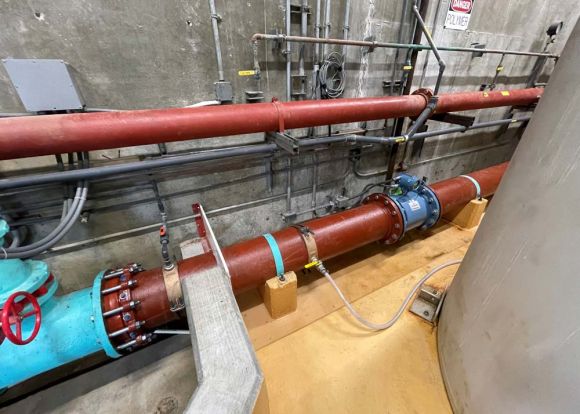

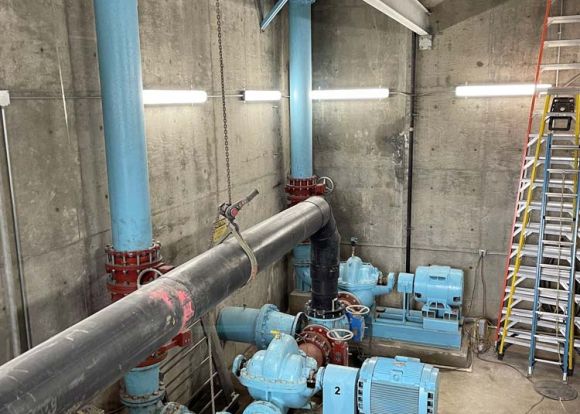

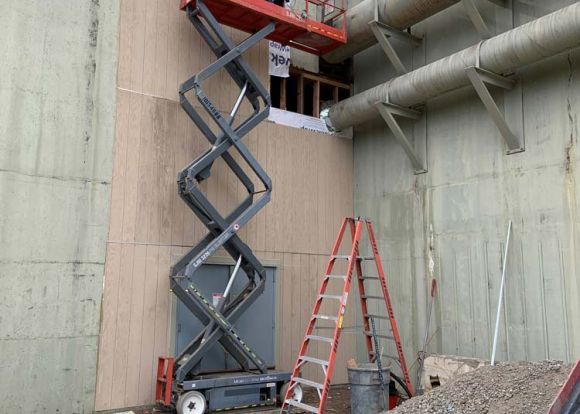

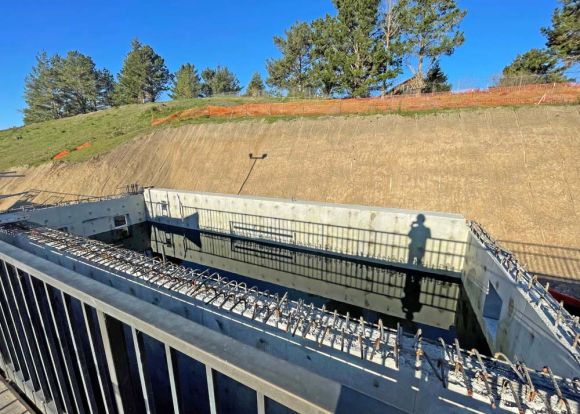

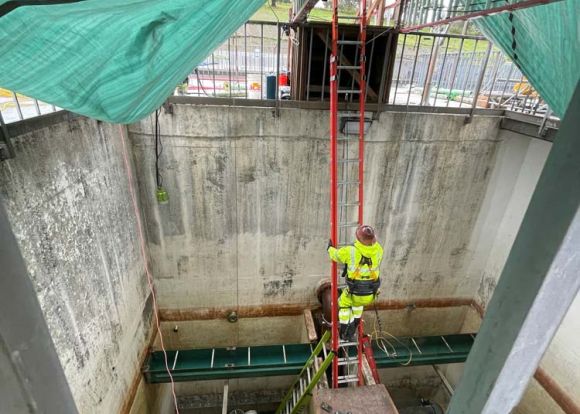

This Project includes (1) the construction of six new wells “in kind” and associated reinforced concrete pads, piping, valves and appurtenances, and connections to the existing raw water pipeline; (2) destroying five existing production wells; (3) converting one existing production well into a monitoring well; (4) installation of six new submersible pumps; and (5) installation of new electric and controls equipment. Modernizations include adding variable frequency drives (VFDs) at all of the pumps; adding integration with the District’s supervisory control and data acquisition (SCADA) system for remote monitoring and automated control; and adding manual transfer switches for emergency generators.

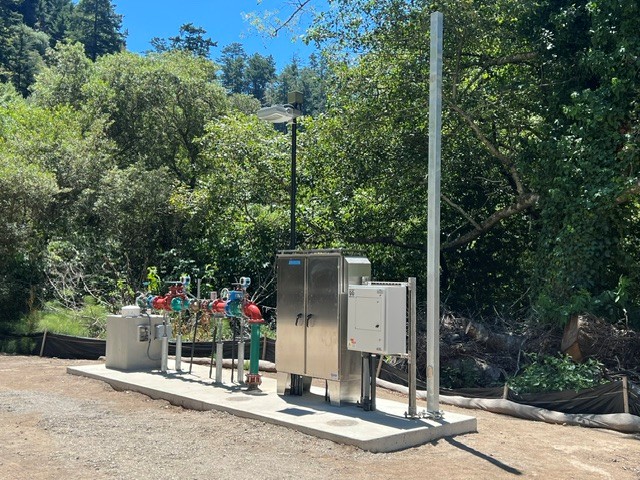

Pilarcitos Wellfield Replacement Project

Completed Projects

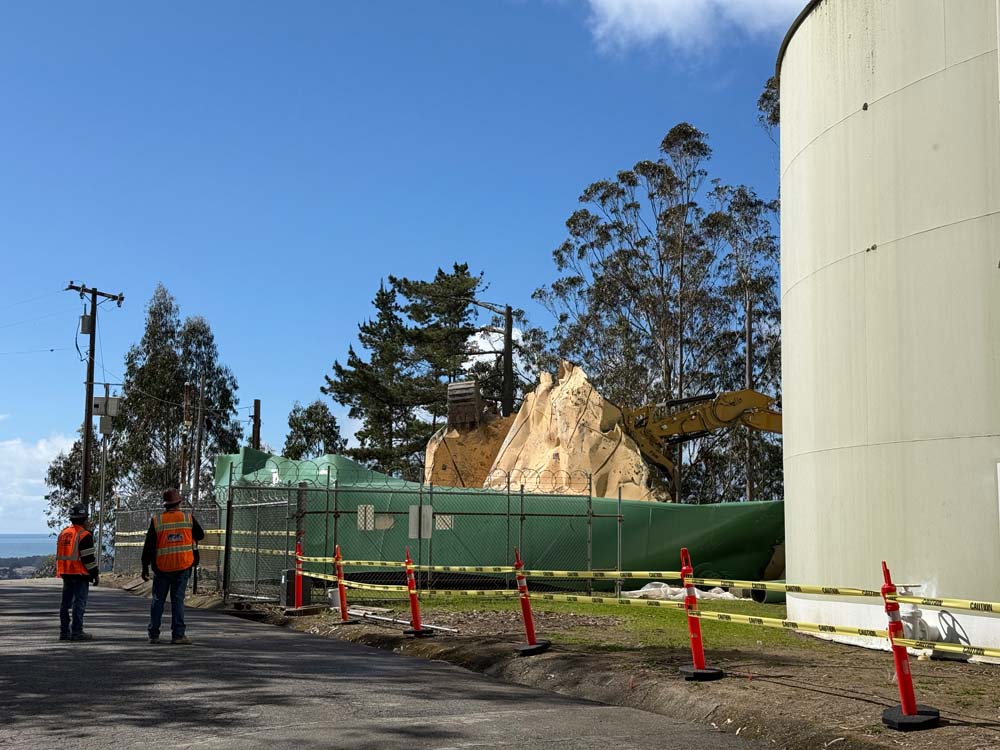

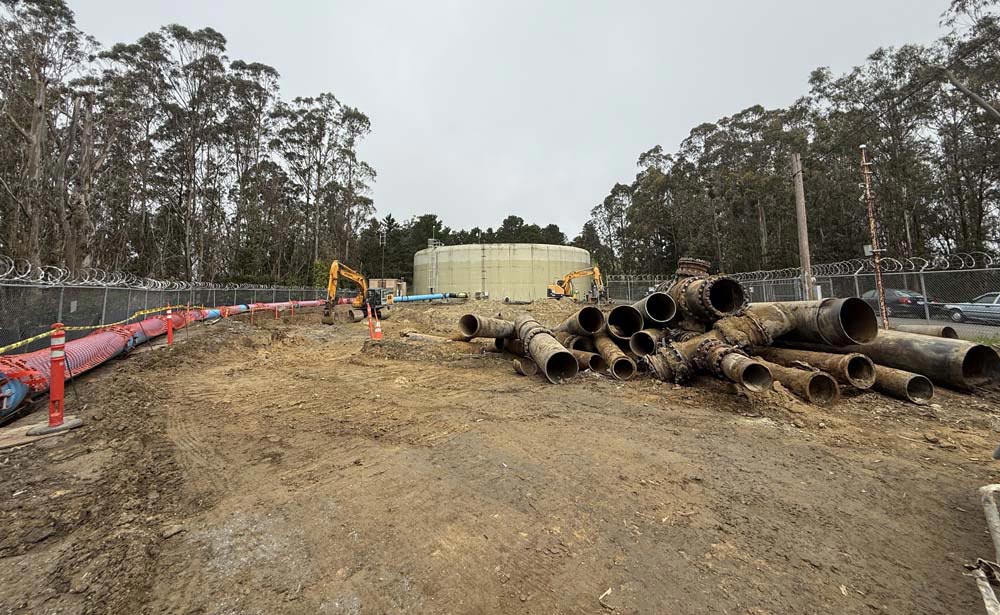

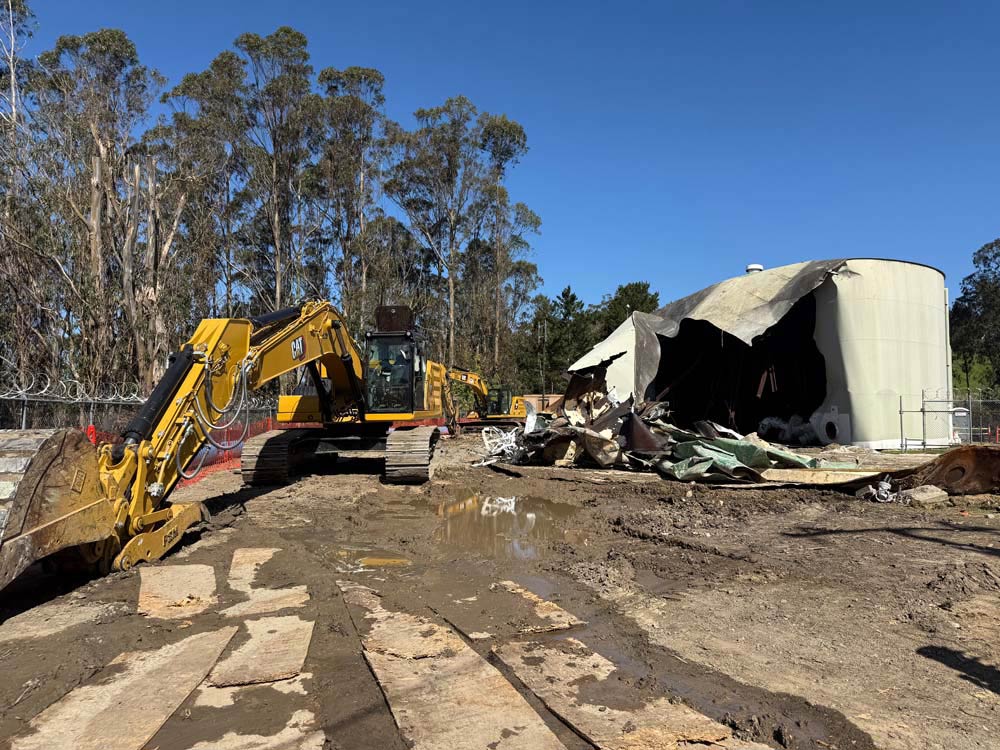

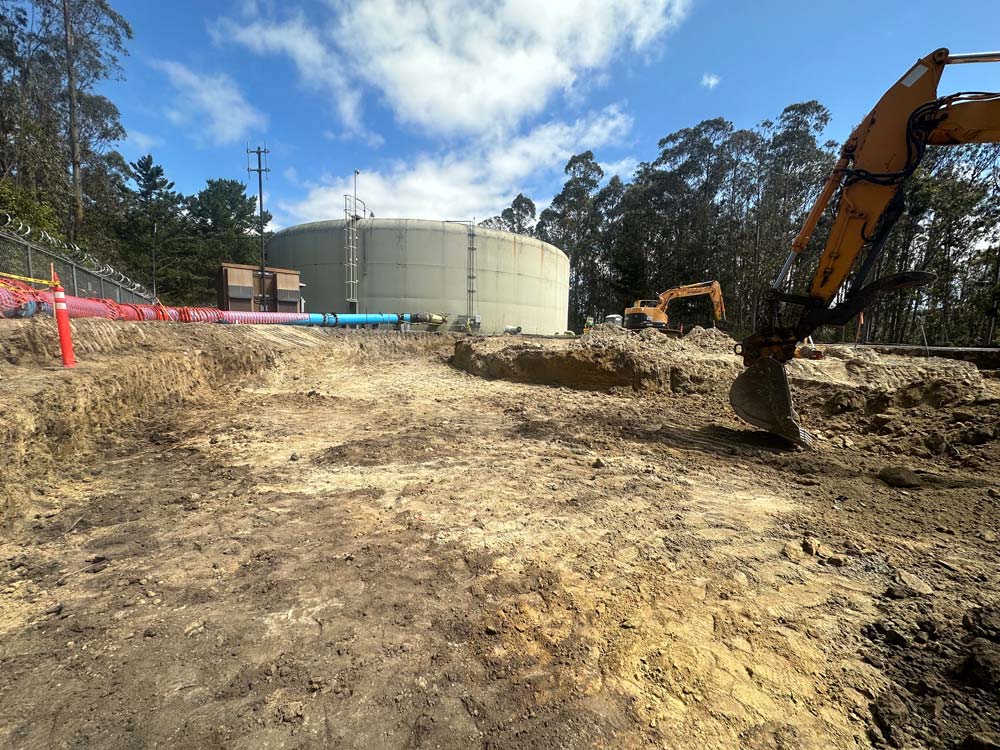

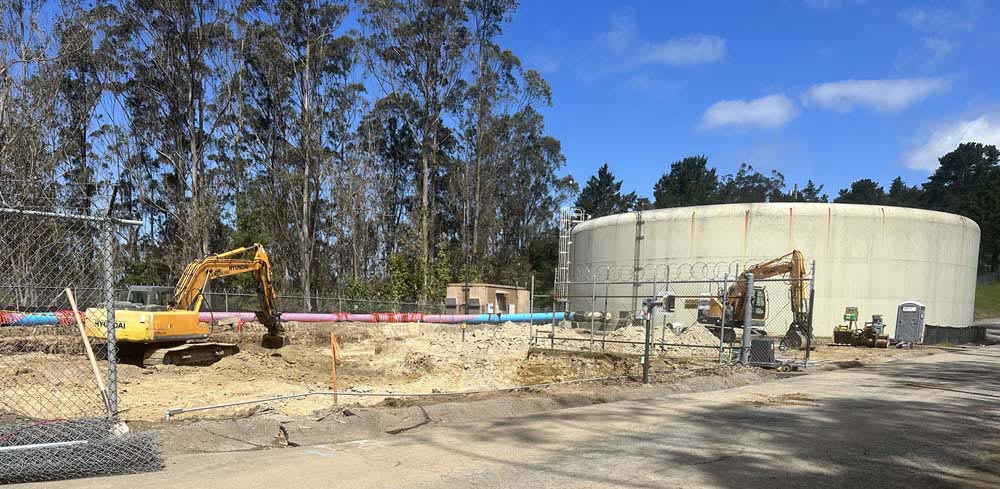

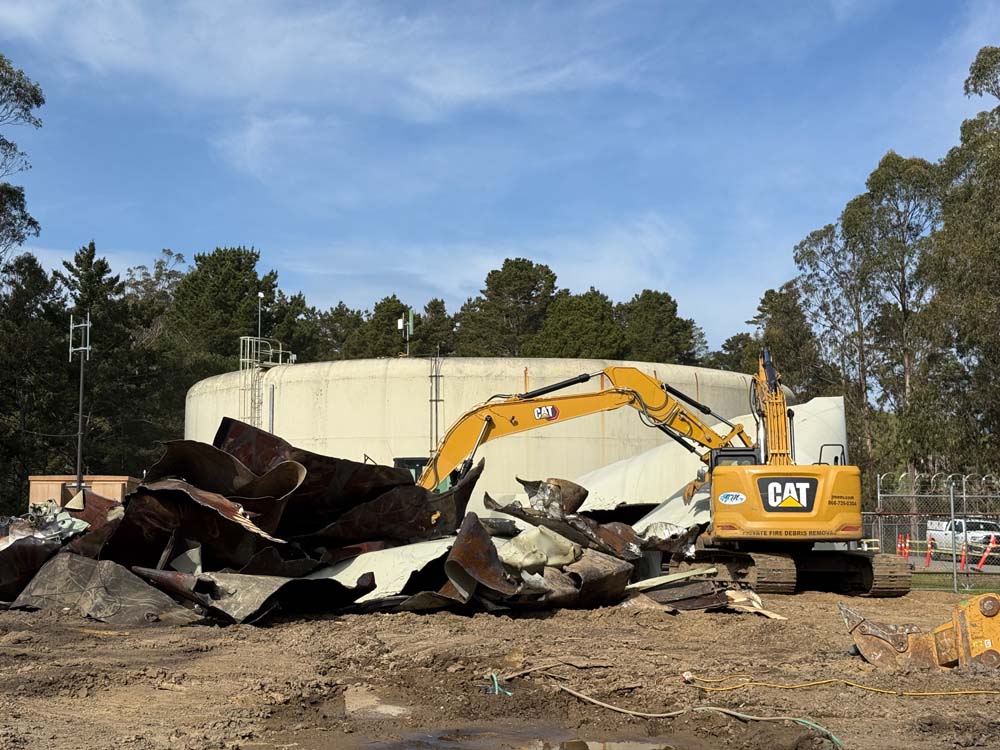

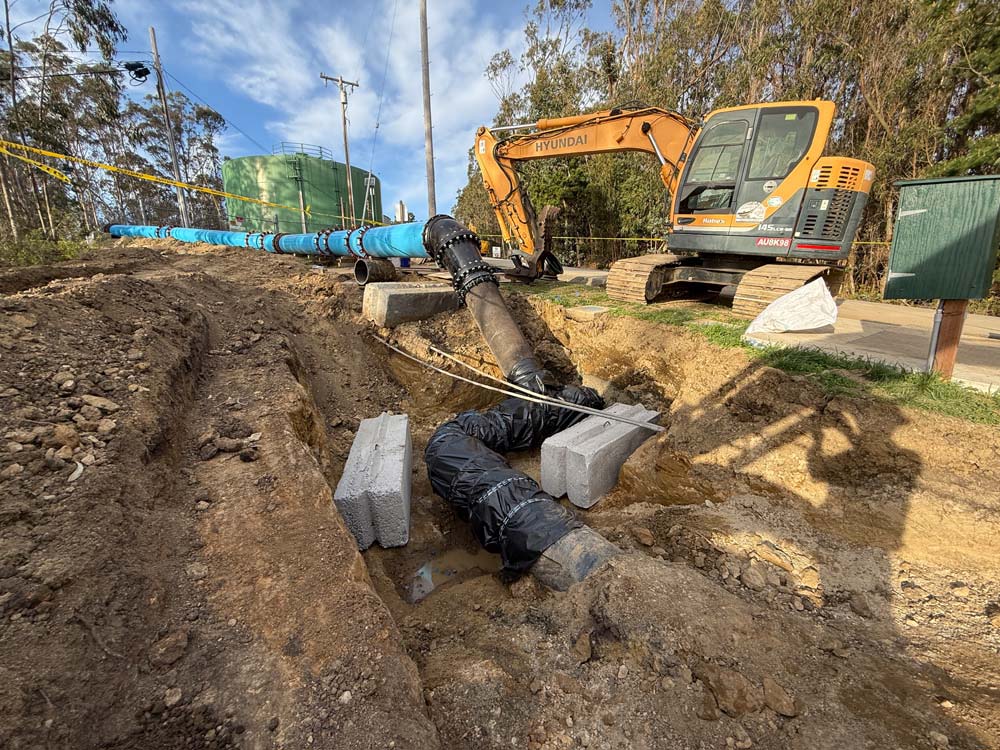

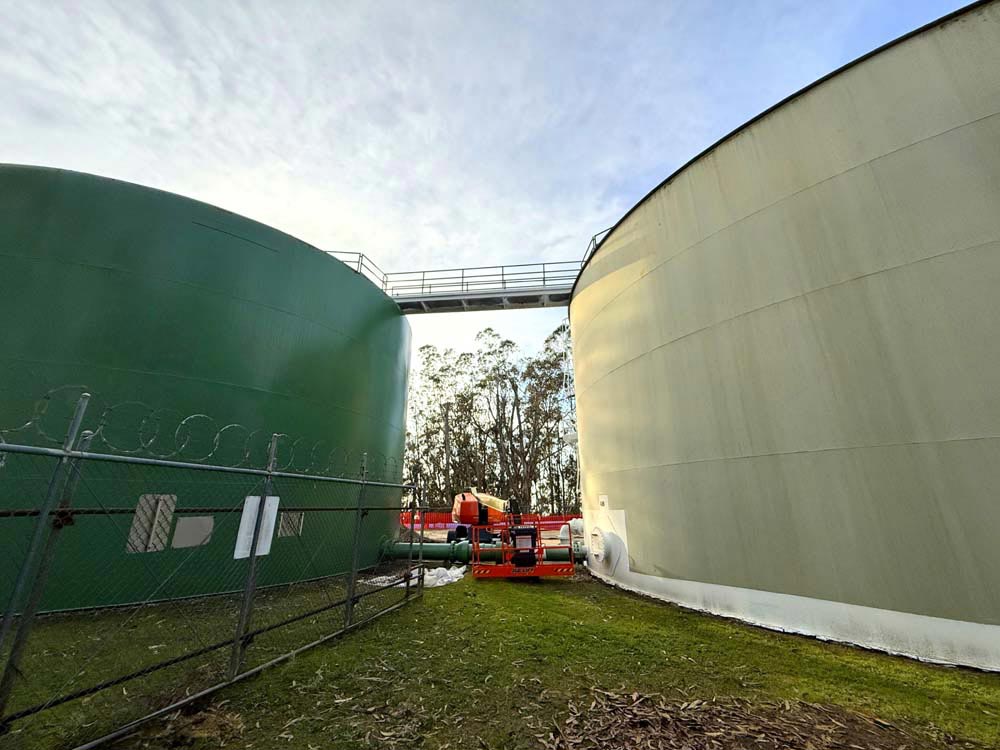

Completed June 2026

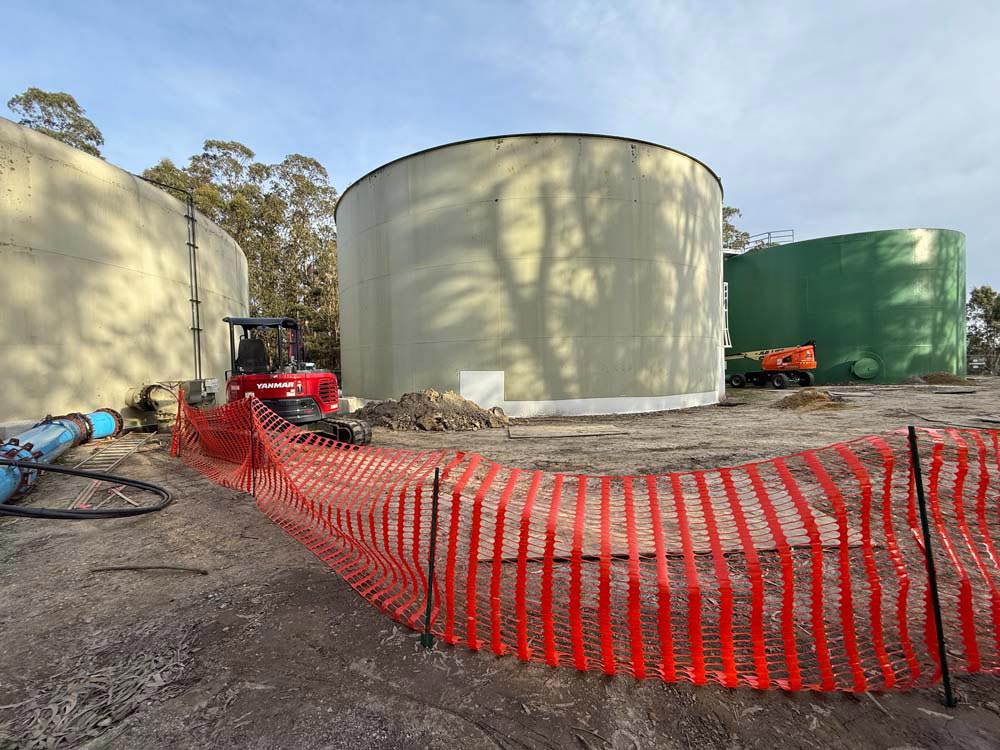

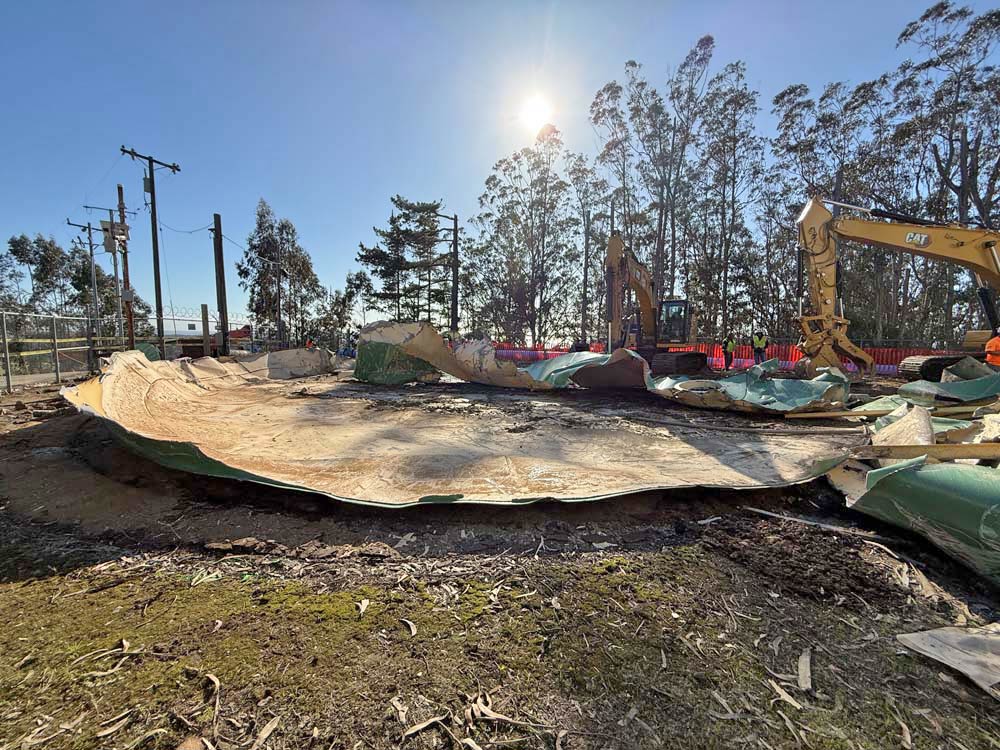

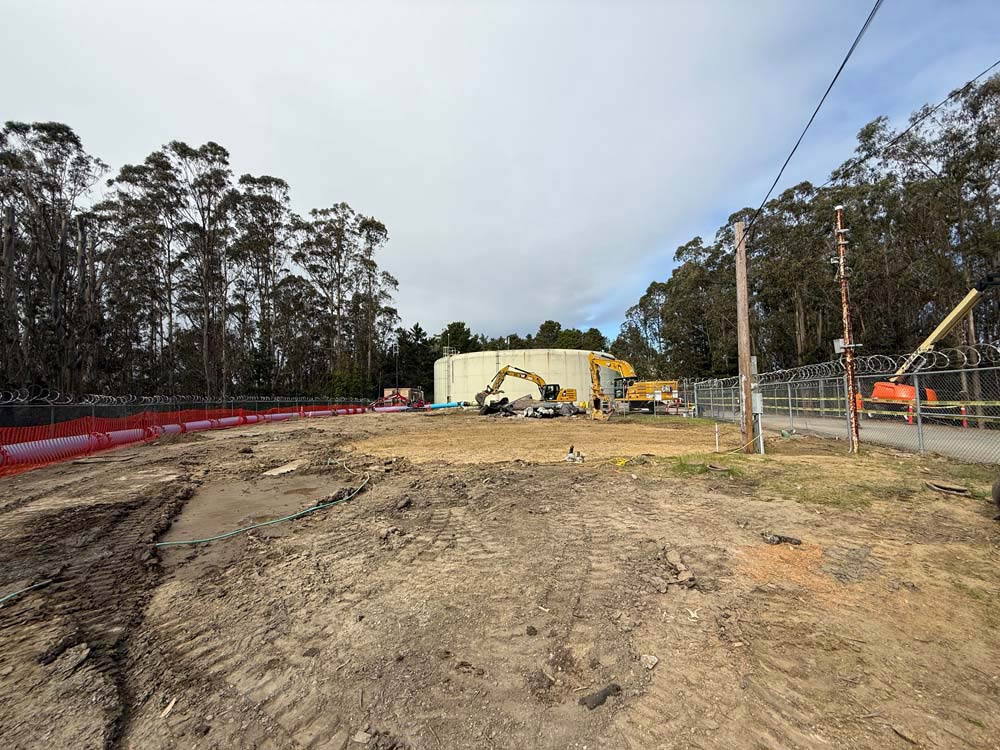

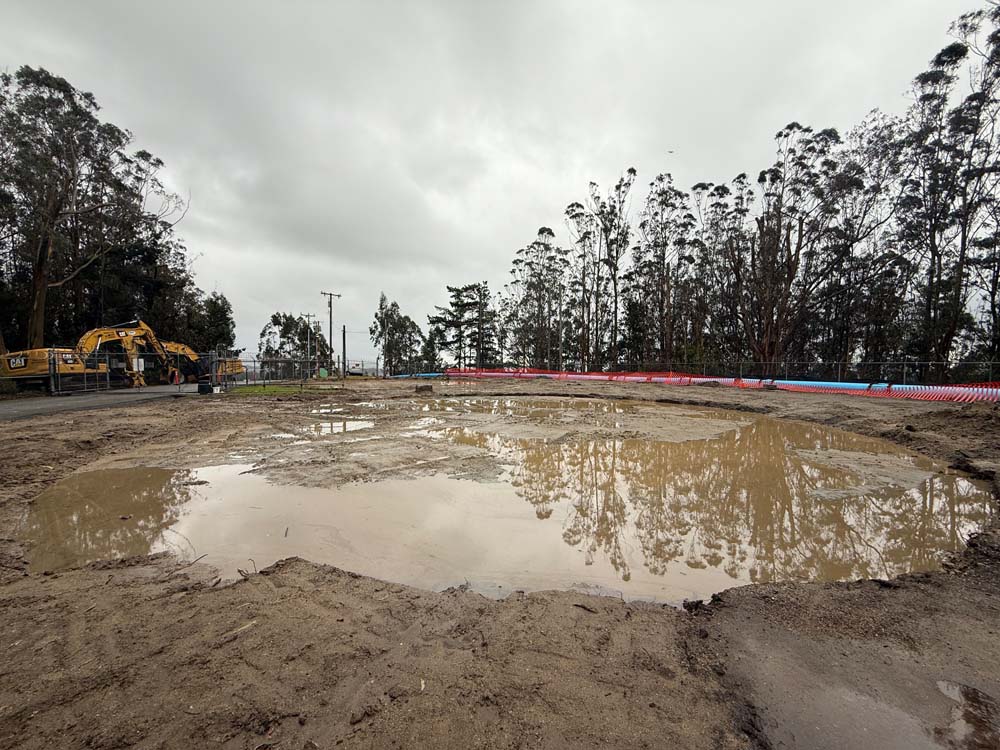

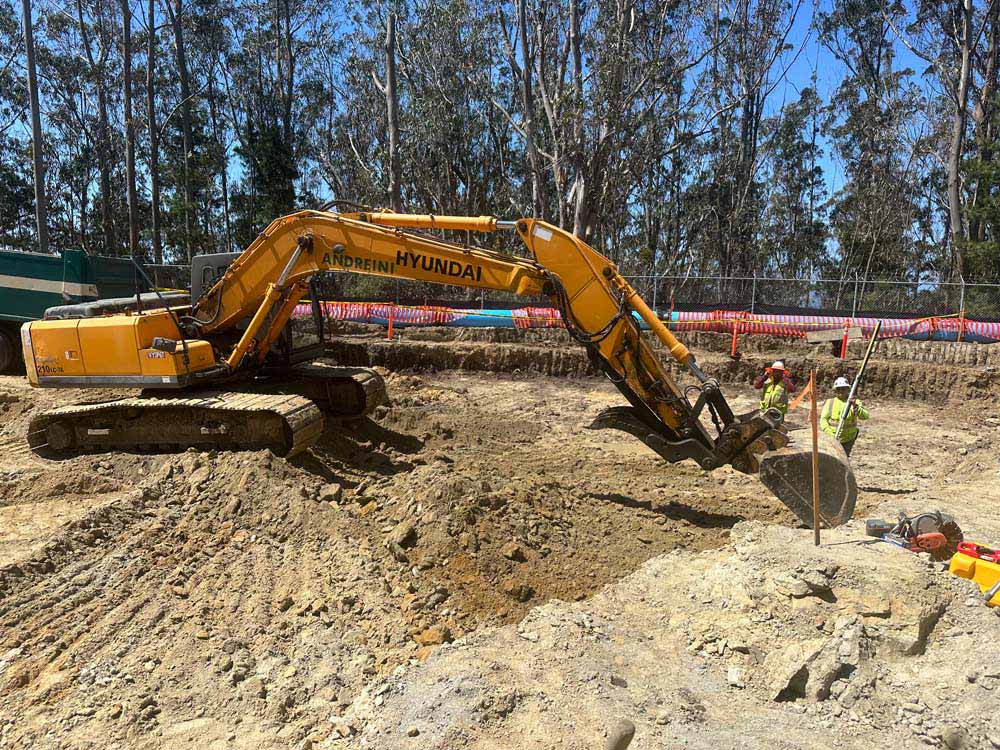

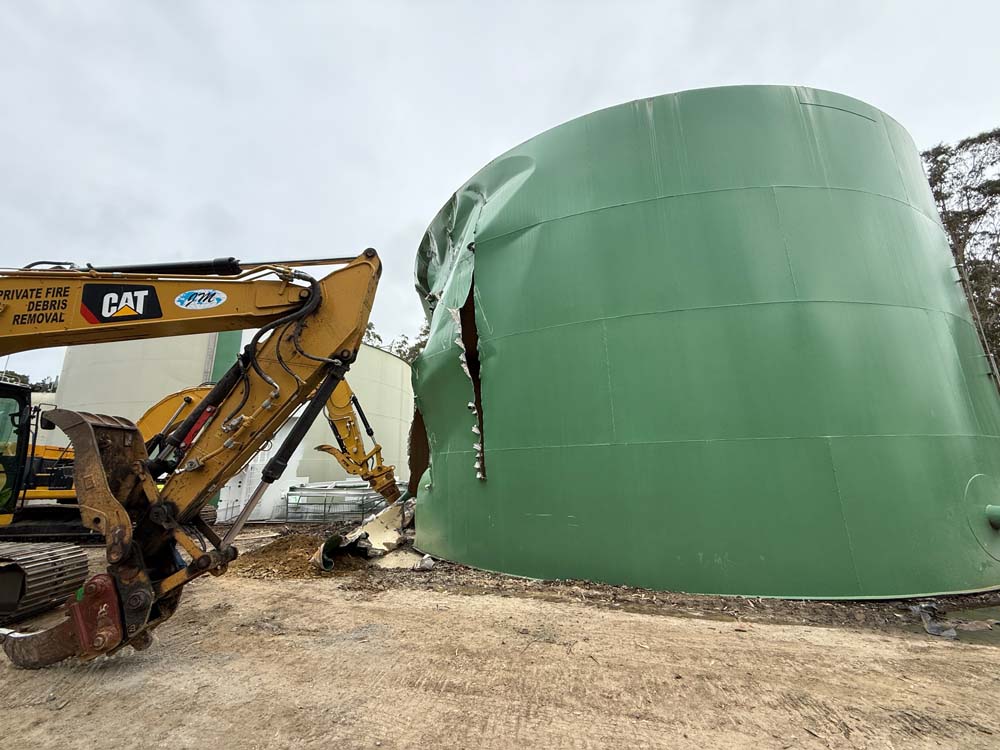

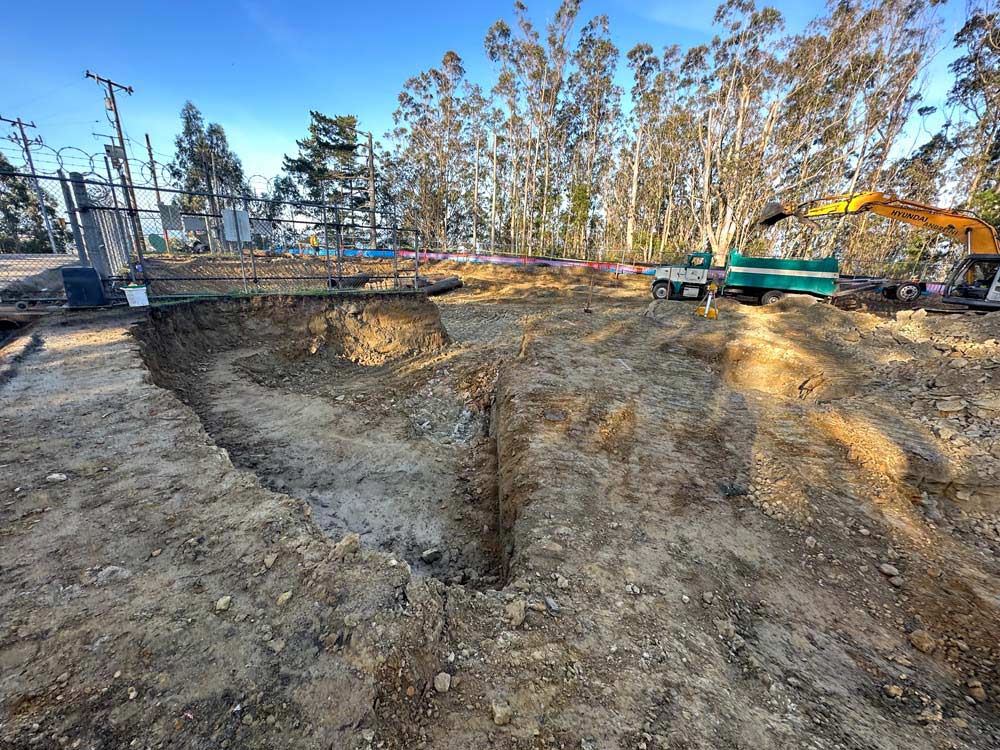

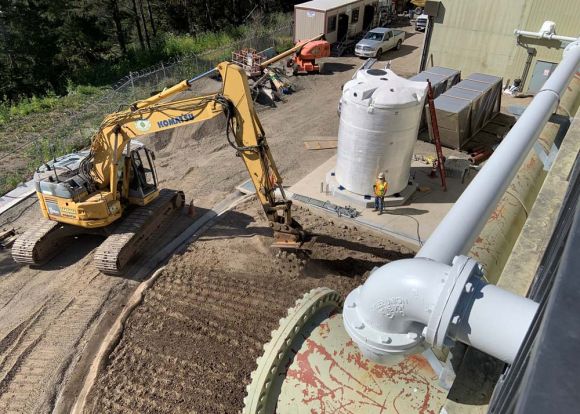

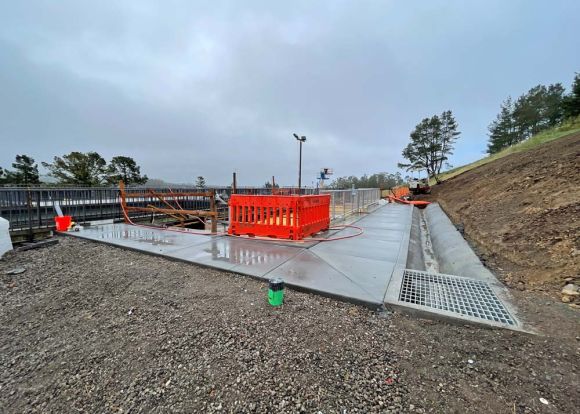

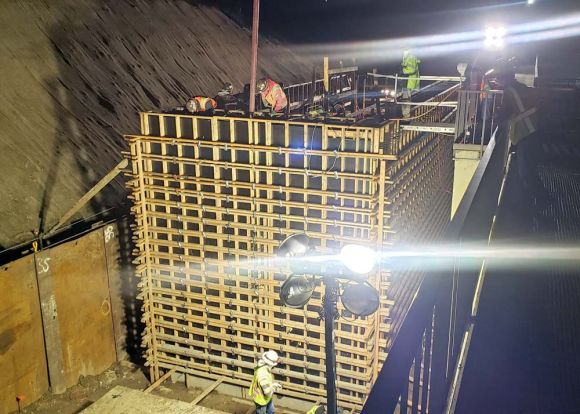

Half Moon Bay Prestressed Concrete Tank and Seismic Upgrades Project

Estimated Project Cost: $12,000,000
LEARN MORE

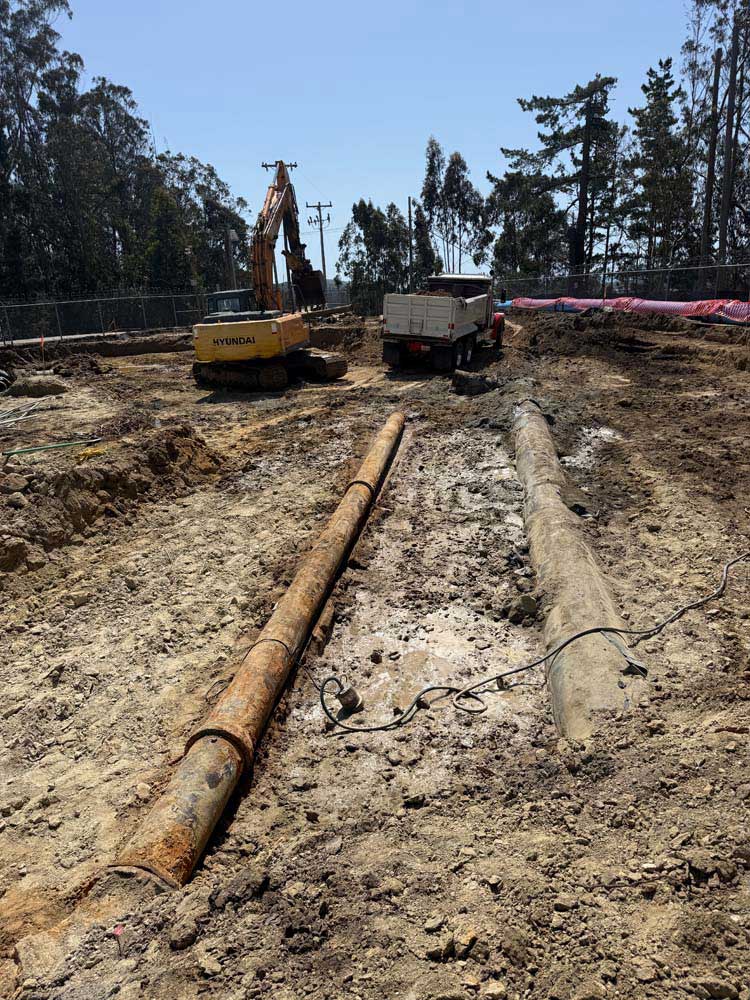

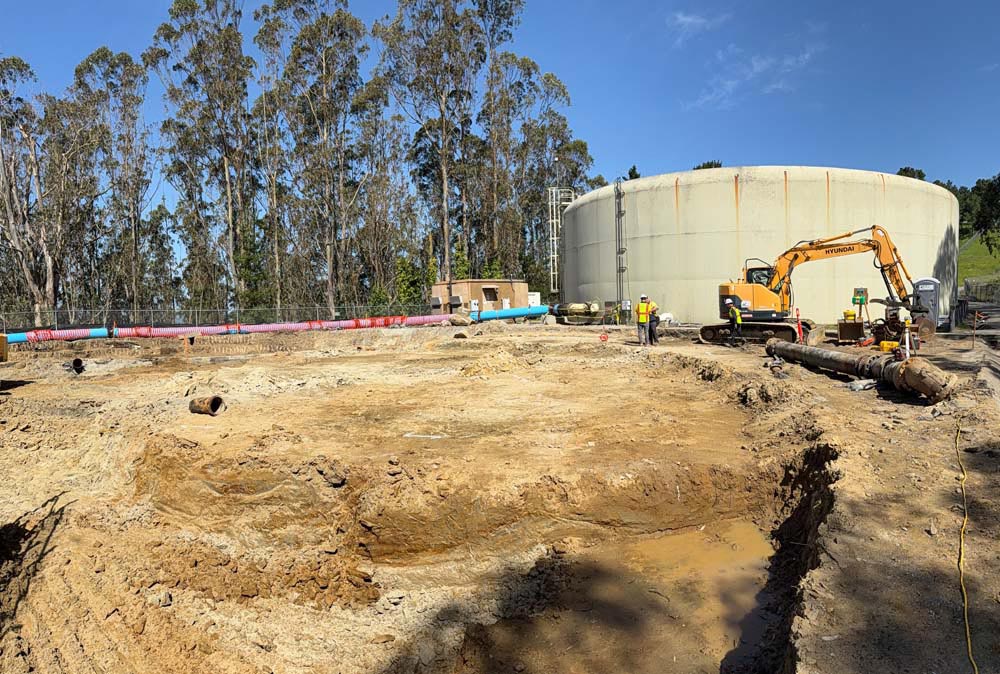

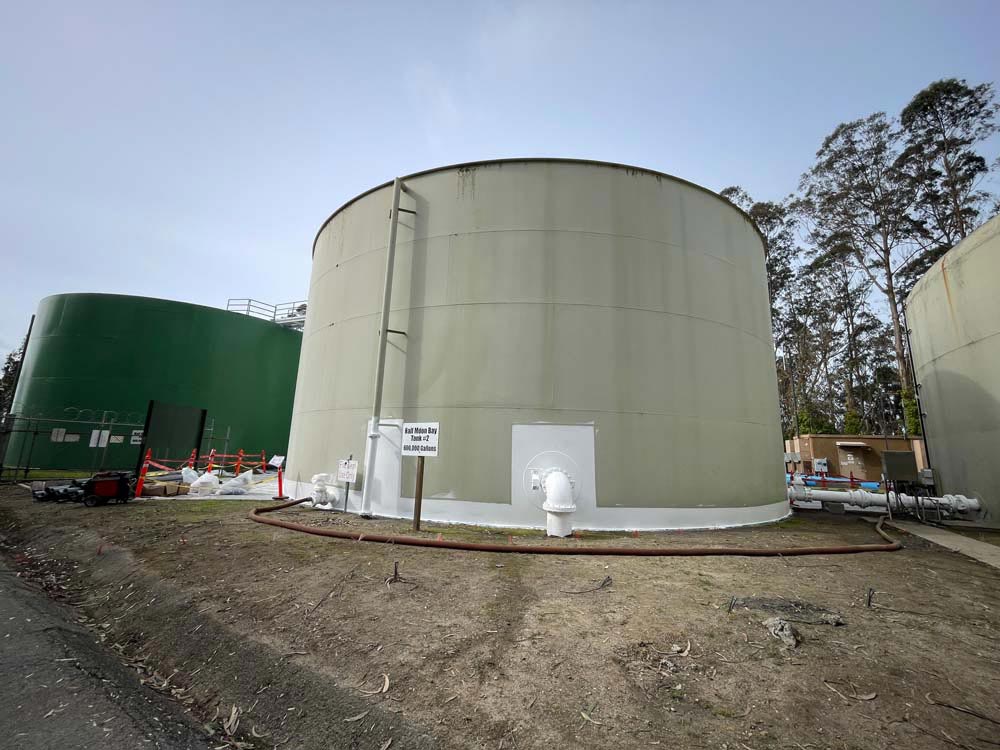

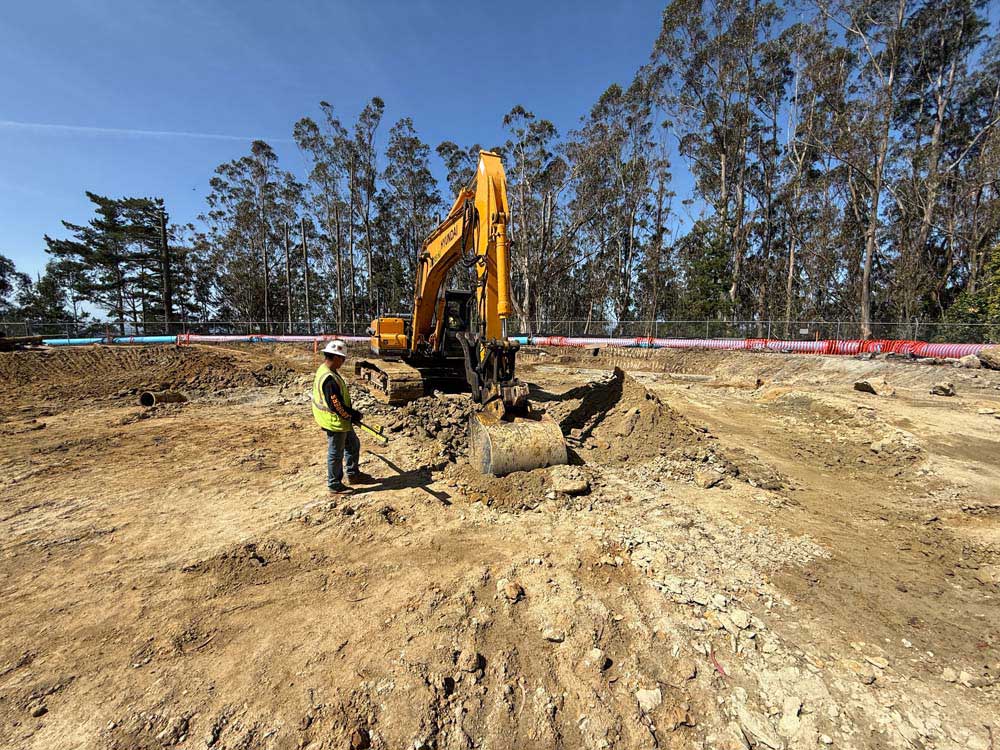

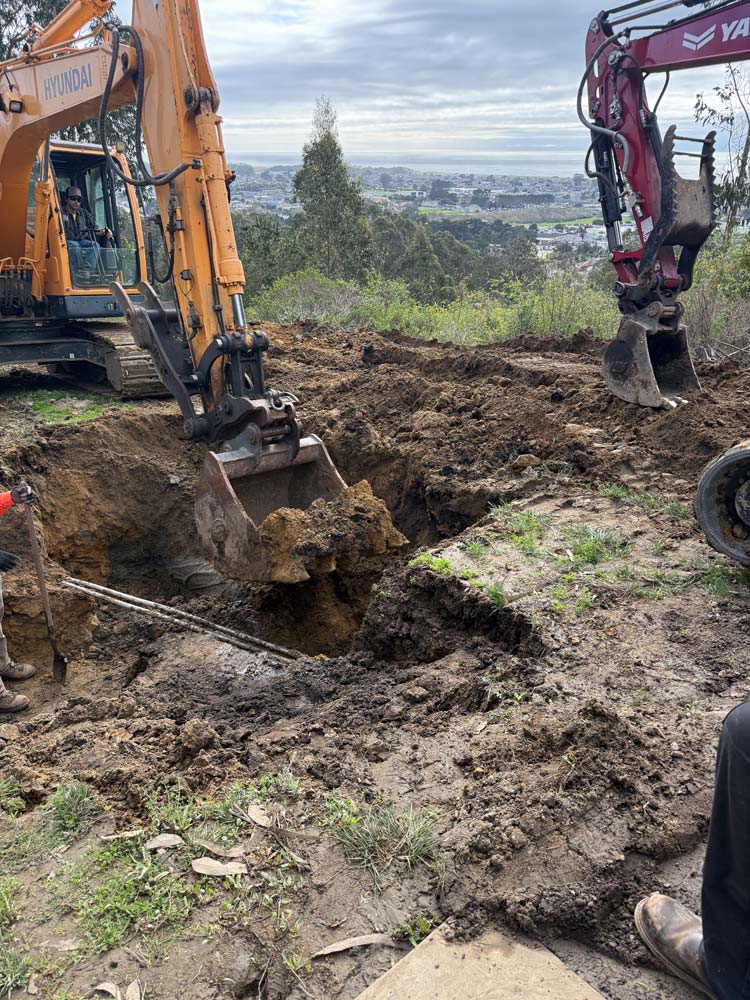

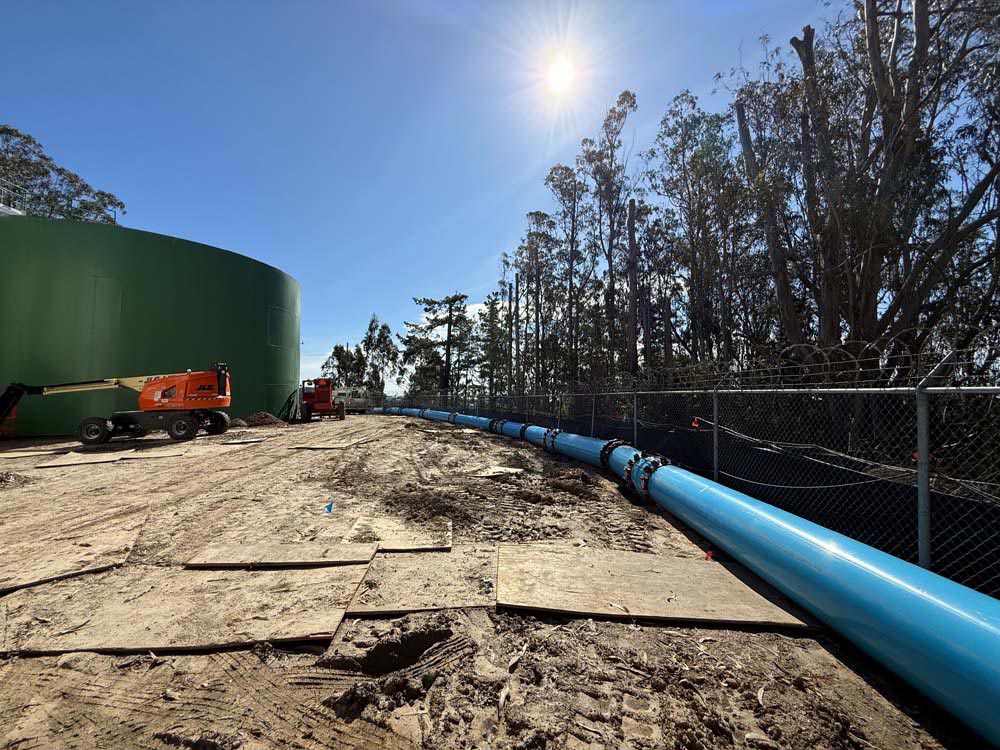

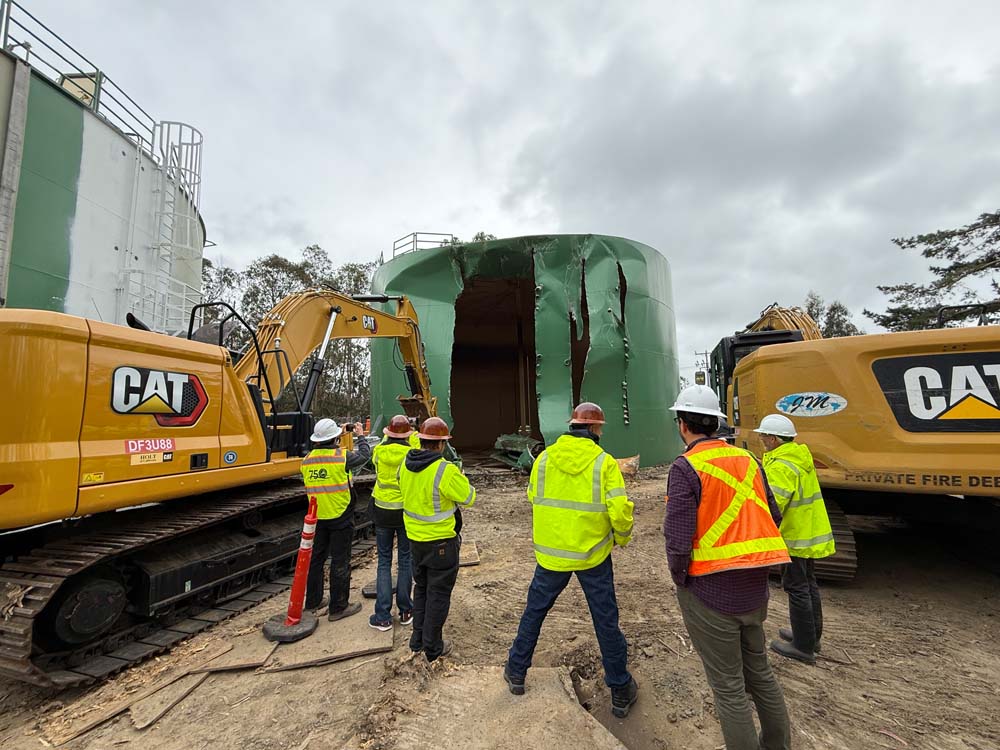

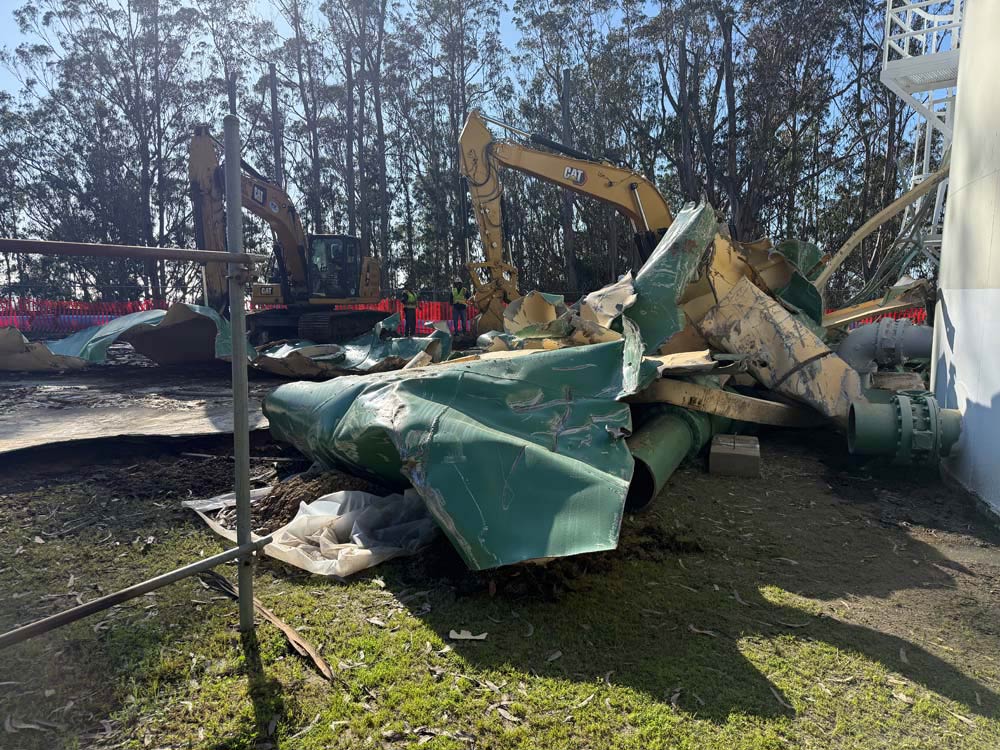

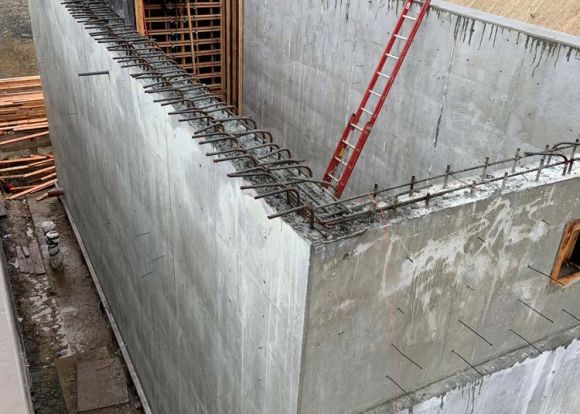

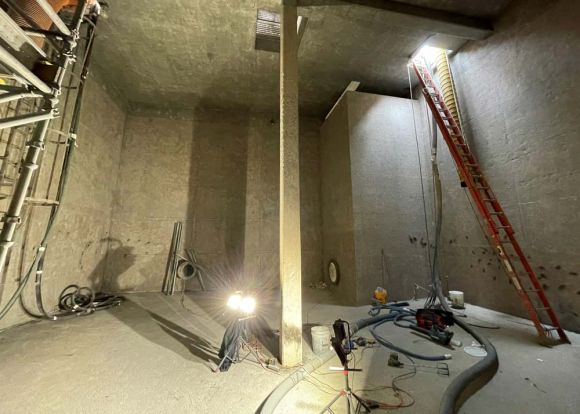

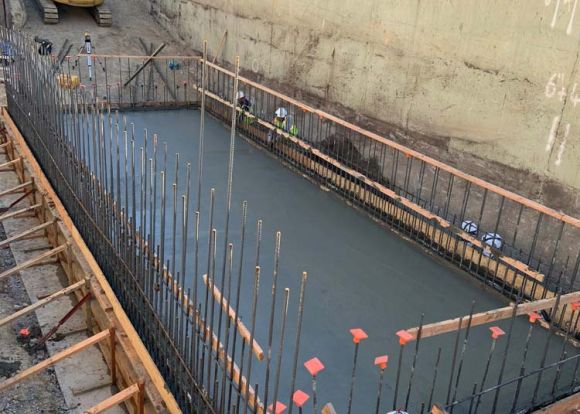

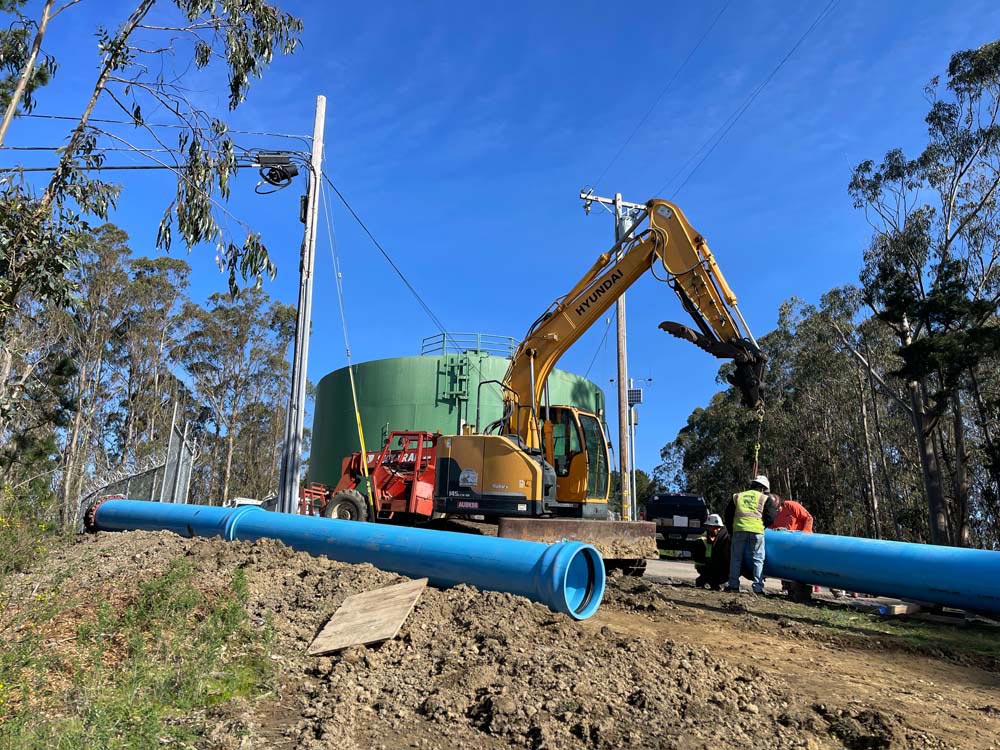

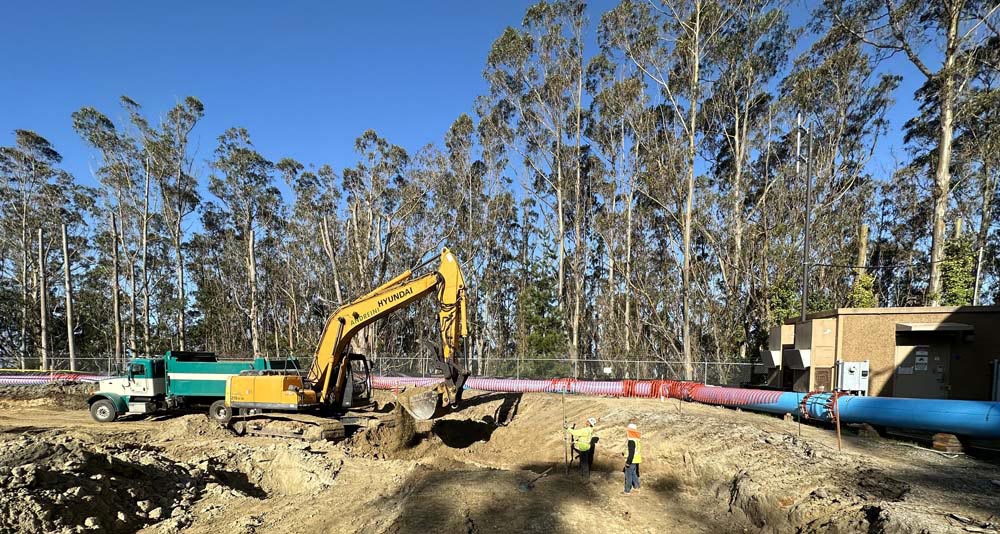

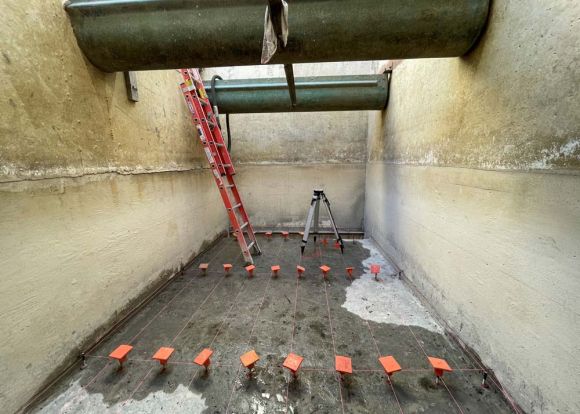

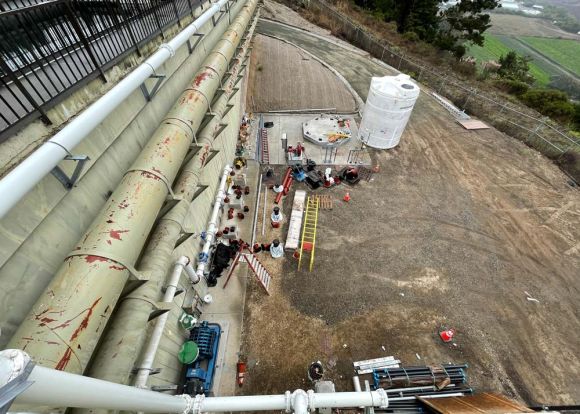

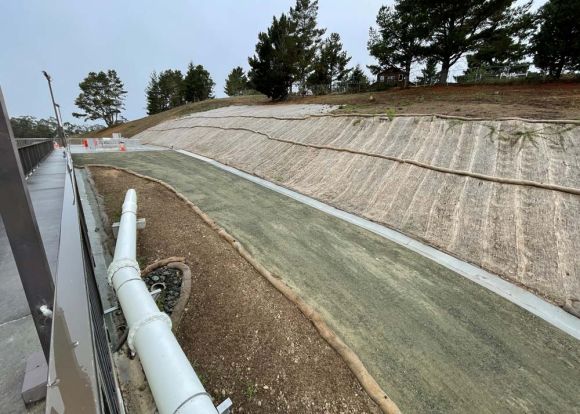

The Half Bay Prestressed Concrete Tank & Seismic Upgrades Project replaced two 1950’s smaller steel tanks located on “Carter Hill” near the Nunes Water Treatment Plant with a new 2.1 million gallon AWWA D110 Type 1 Prestressed Concrete DN Tank – increasing the District’s treated water storage capacity by 1 million gallons. The new tank is 97 feet in diameter and 55 feet tall, including the dome roof. Construction required nearly 1,000 cubic yards of concrete and 21 miles of high-strength prestressing wire.

Why did the District choose concrete over steel? Prestressed concrete tanks are known for their seismic resilience and enhanced water quality protection. They also offer a significant long-term maintenance advantage. Over an 80–100-year service life, a concrete tank requires far less maintenance than a steel tank. In a coastal environment, steel tanks typically require recoating and rehabilitation about every 20 years. The chart below compares the 80-year lifecycle costs of concrete and steel, demonstrating why prestressed concrete was the clear long-term choice for the District.

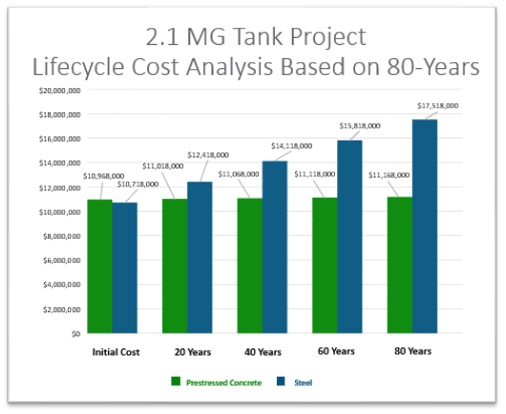

2.1 MG Tank Project Lifecycle Cost Analysis Based on 80 Years

Completed July of 2025

Highway 92 Pipeline Replacement Project Phase 1

Project Cost: $3,200,000
LEARN MORE

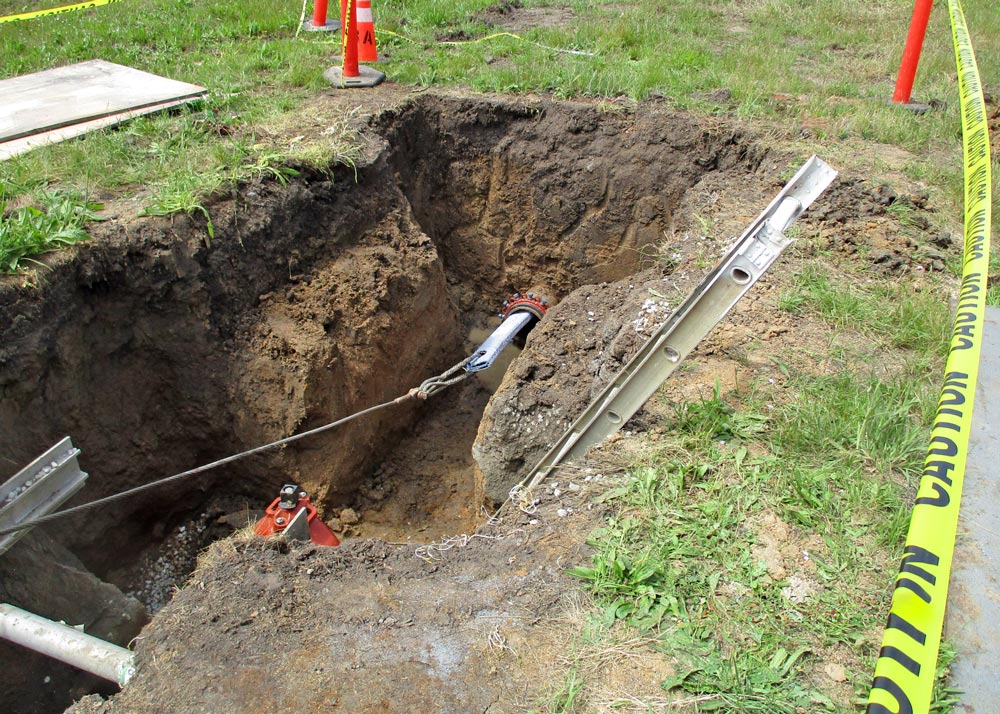

During December 2022/January 2023 winter storms, erosion from the storms exposed segments of the buried pipeline. A temporary bypass 2-inch pipeline adjacent to Highway 92 was installed above ground leaving it at risk to damage and not suitable for long-term use. During a previous storm, another segment of Pipeline was exposed near the Corinda Los Trancos Creek, also putting it at risk for failure. Therefore, this project includes installation of a 12-inch diameter high density polyethylene (“HDPE”) pipe via horizontal directional drilling under Corinda Los Trancos Creek and two crossings of Pilarcitos Creek, with the rest of the pipeline consisting of 10-inch and 6-inch diameter ductile iron pipe installed via open trench. The total length of the new water main is 5,665 linear feet.

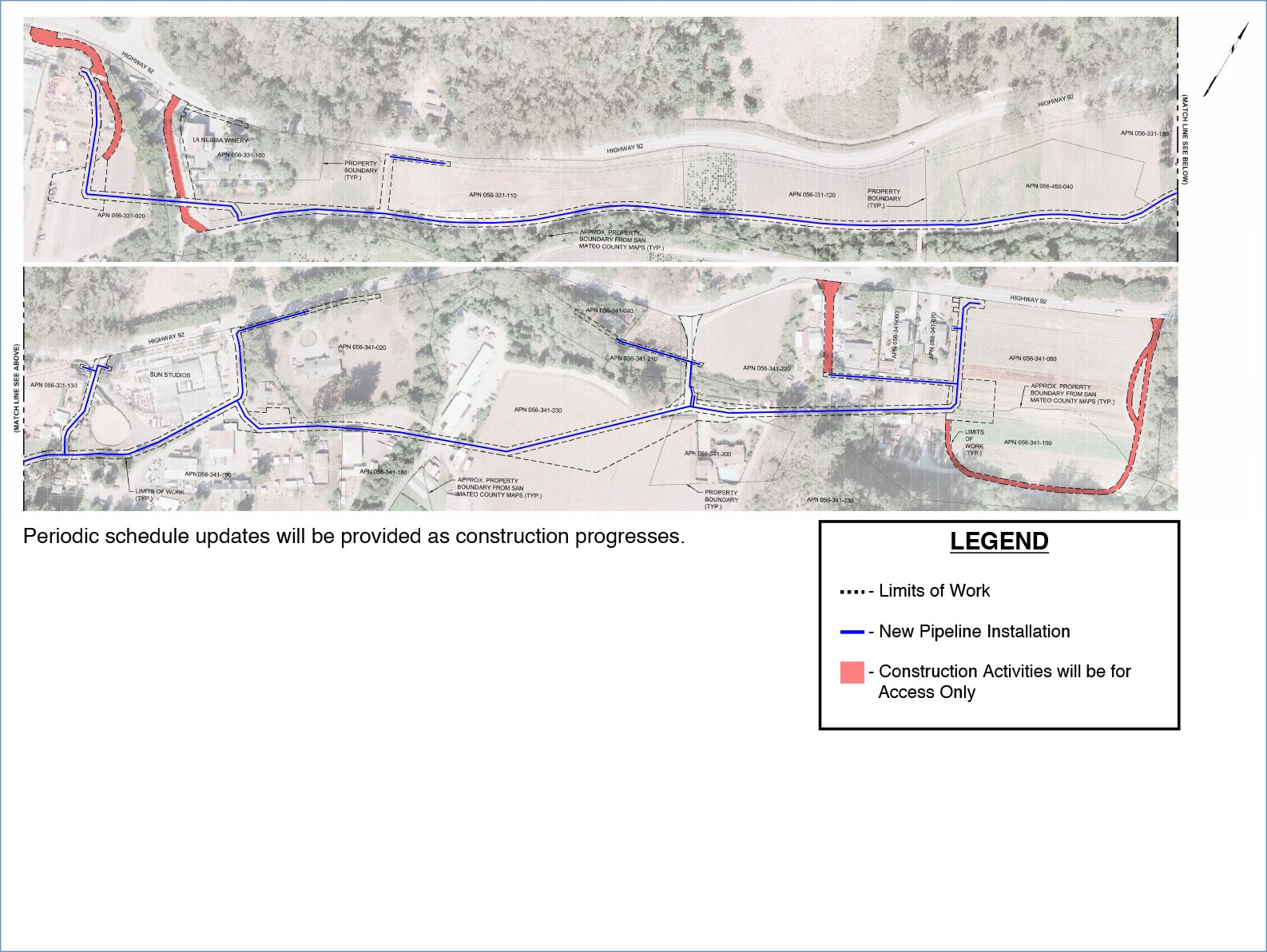

Highway 92 Pipeline Replacement Project Phase 1 map with legend

    Advantage Reline video showing Magellan/Hwy 1 Pipeline Restoration Project using Primus Line to line existing cast iron pipeline.

      Completed July of 2024

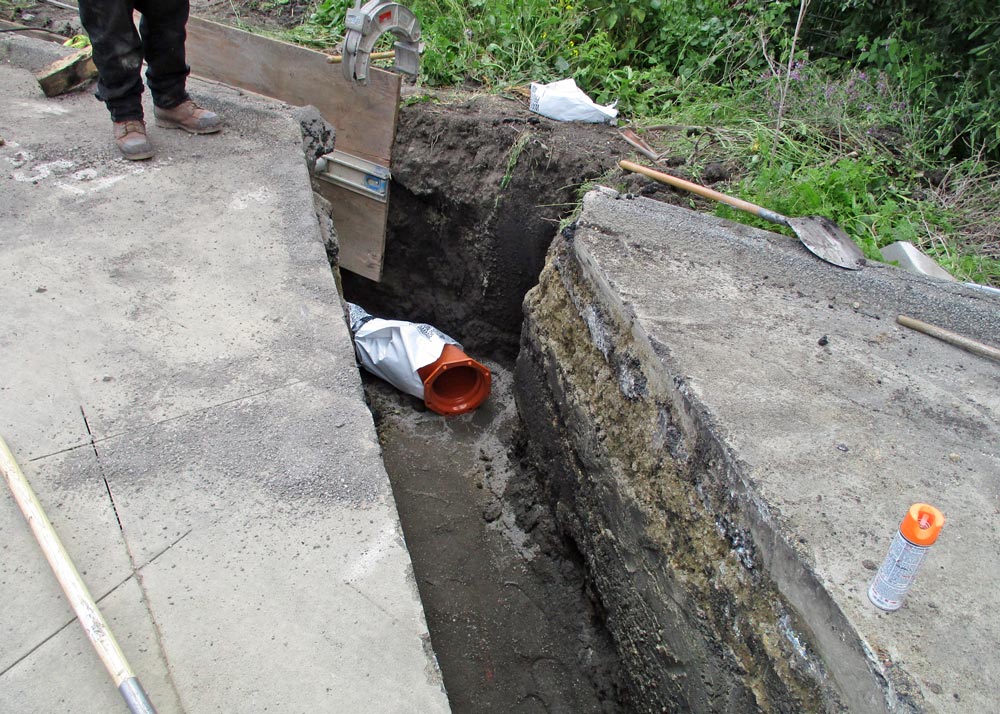

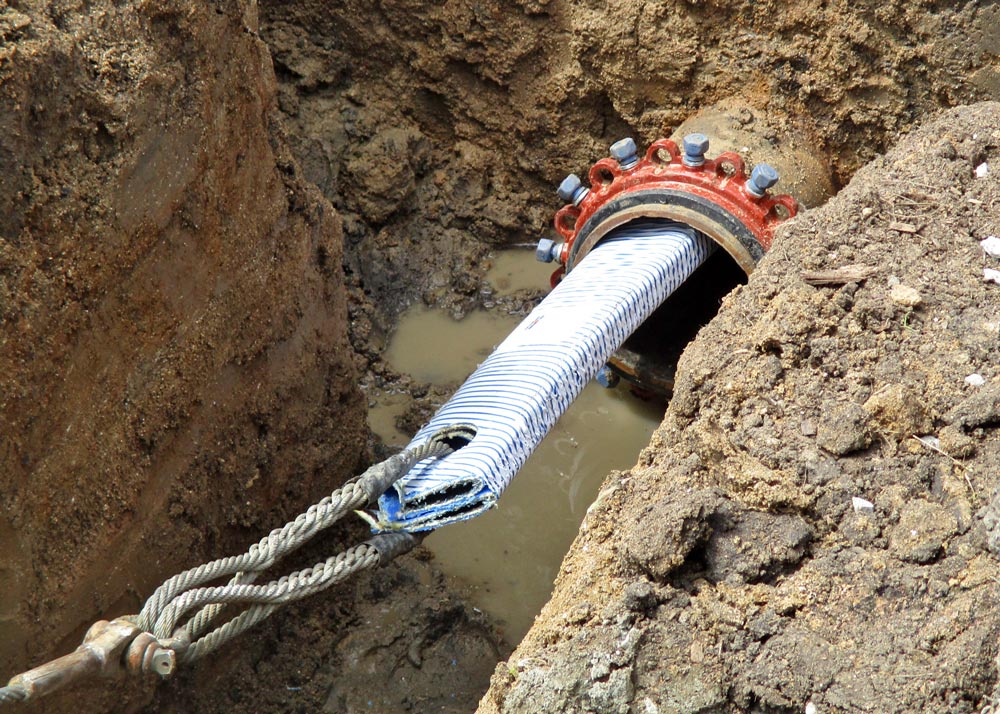

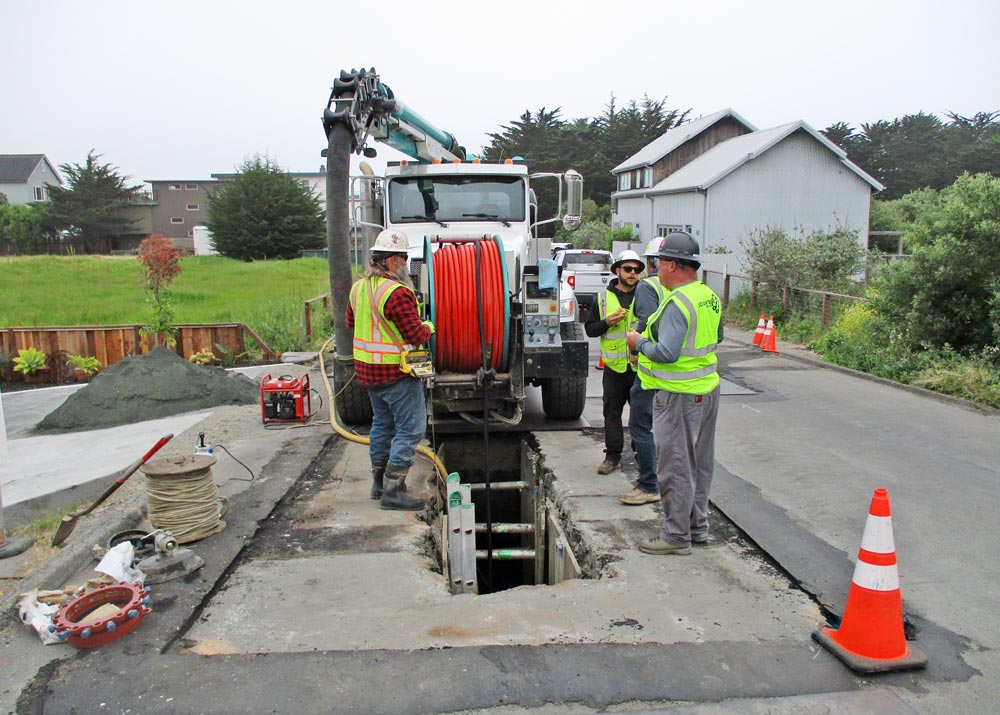

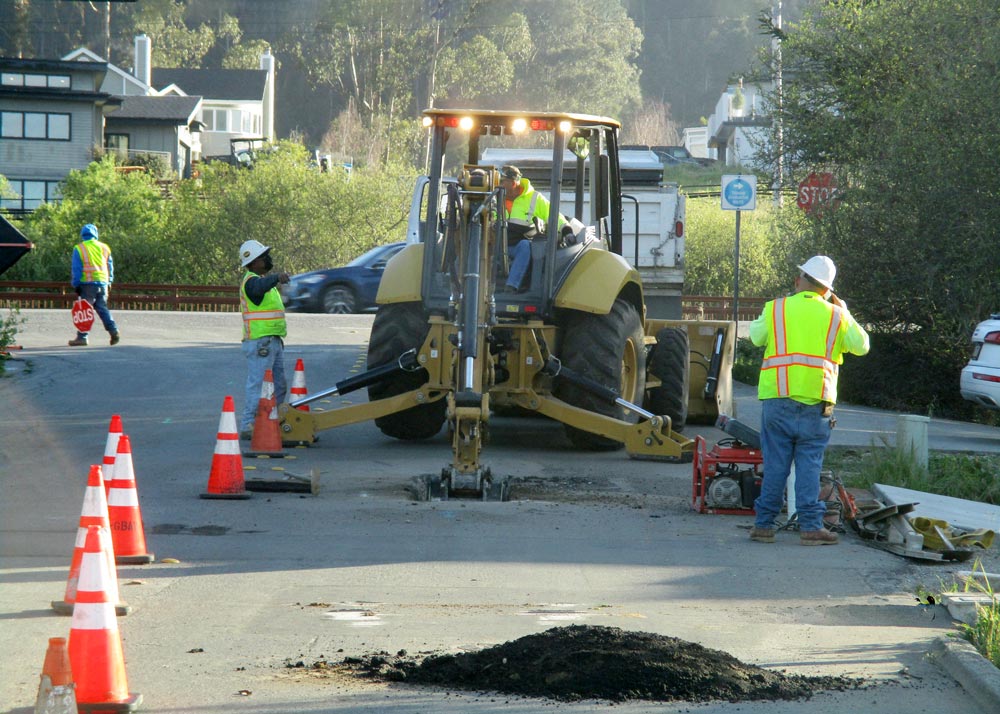

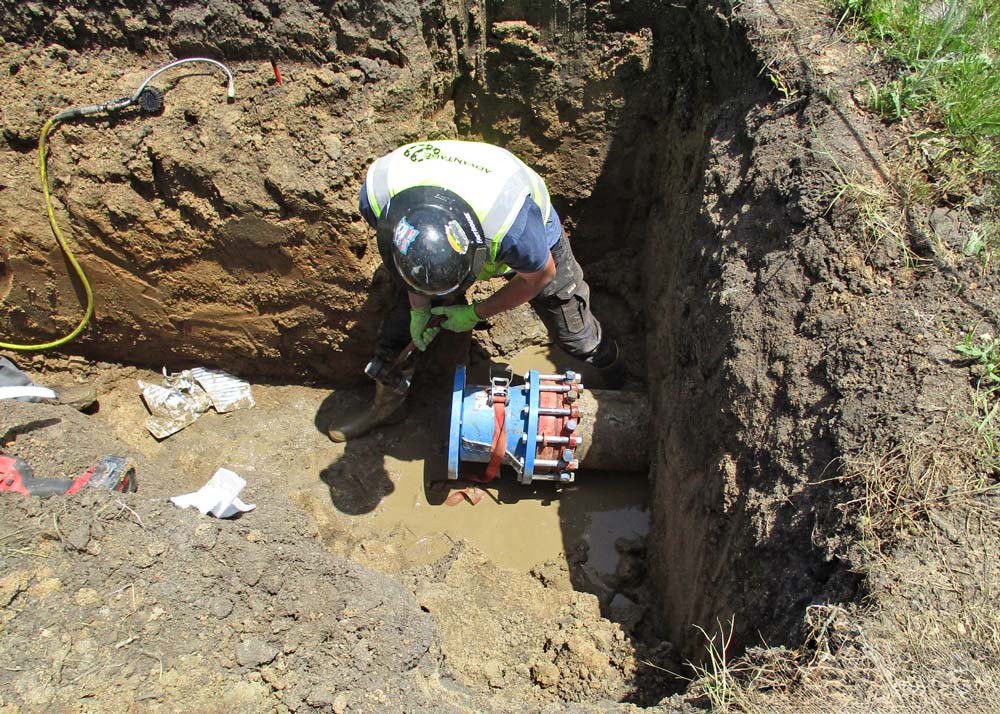

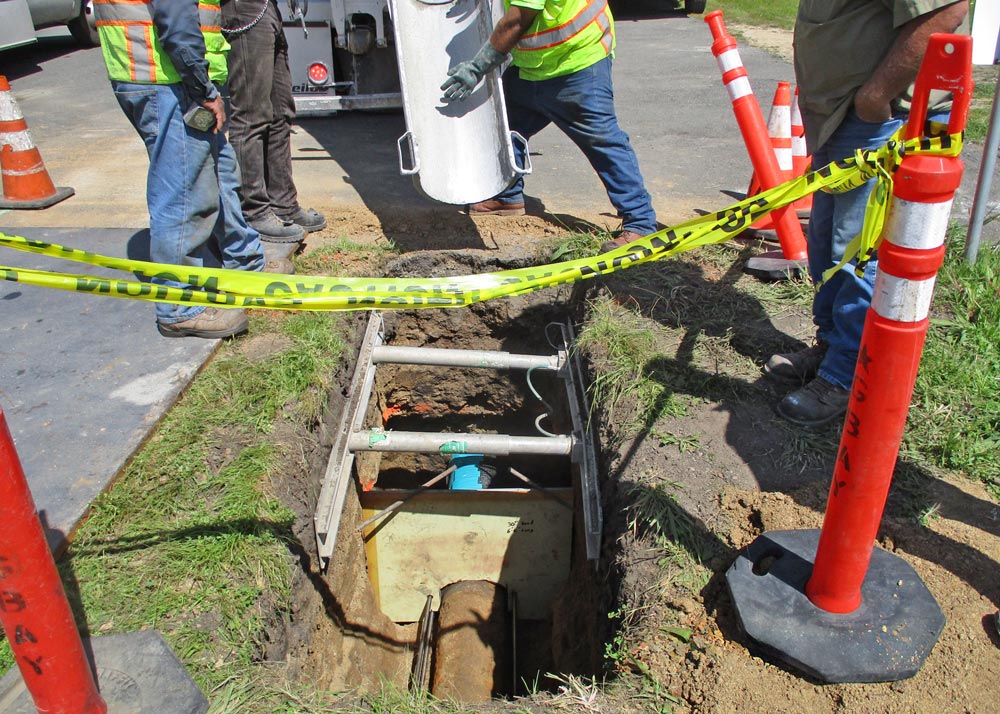

      Magellan/Highway 1 and Alameda Avenue Pipeline Restoration Projects

      Project Cost: $500,000
      LEARN MORE

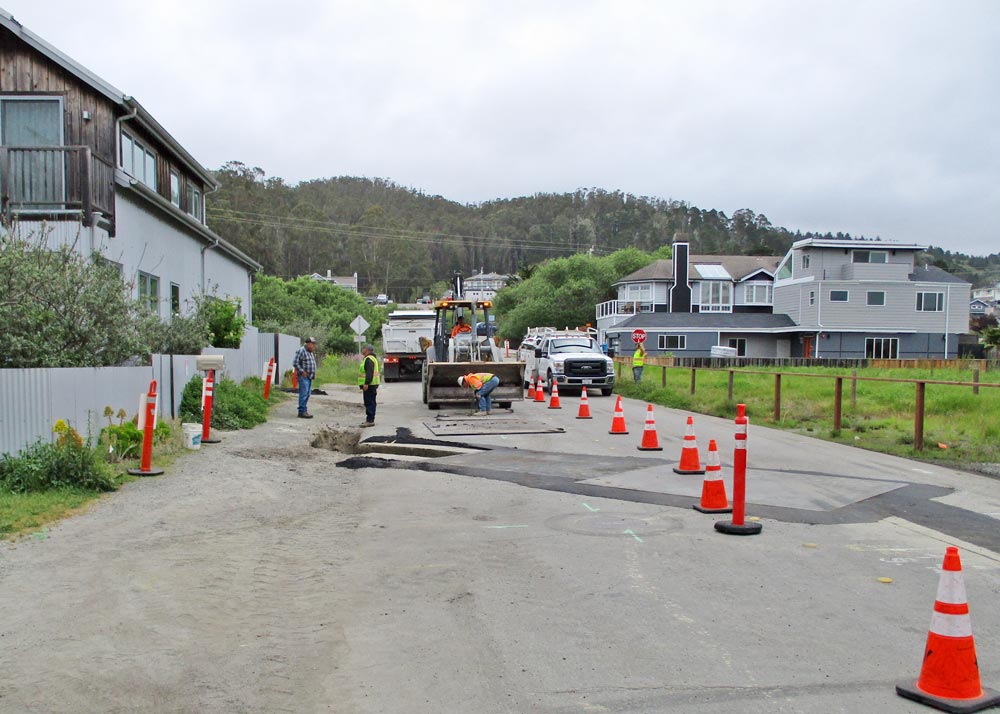

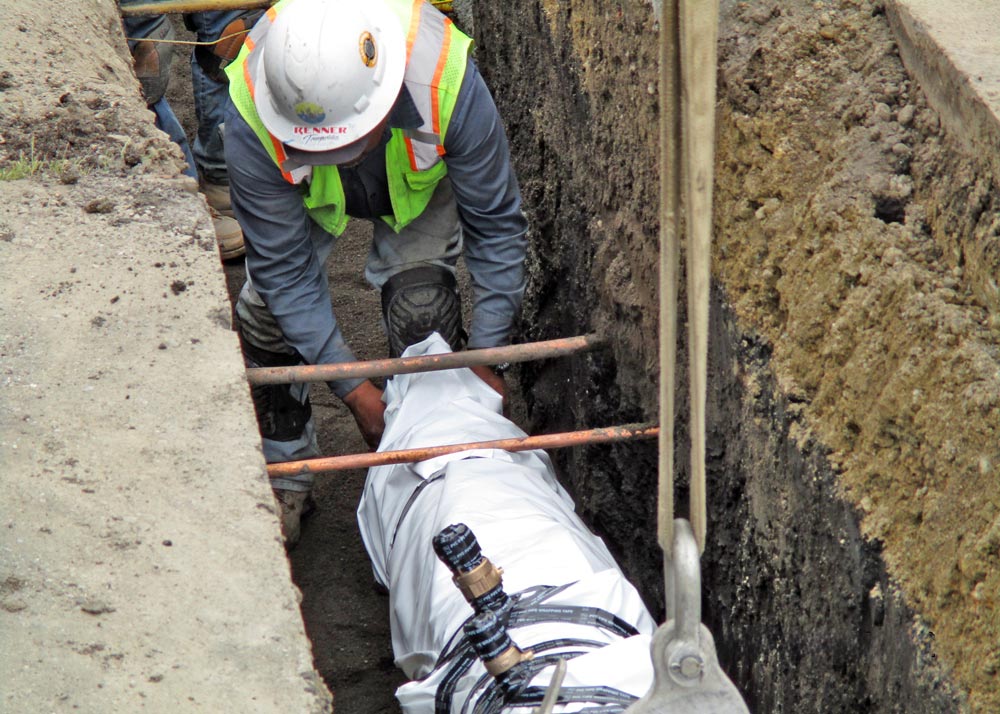

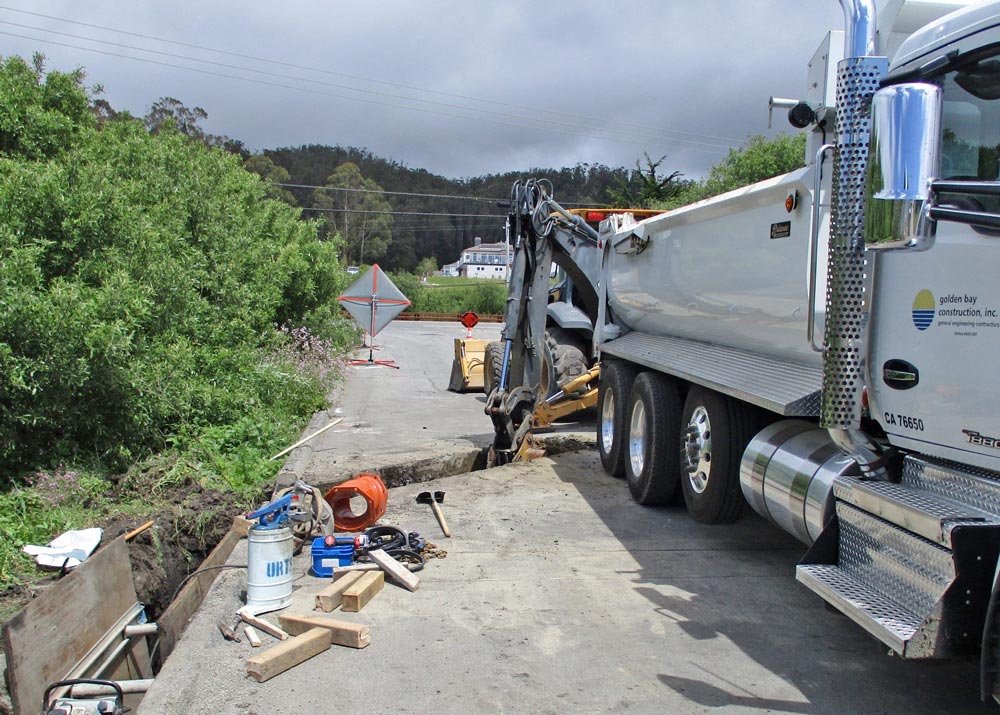

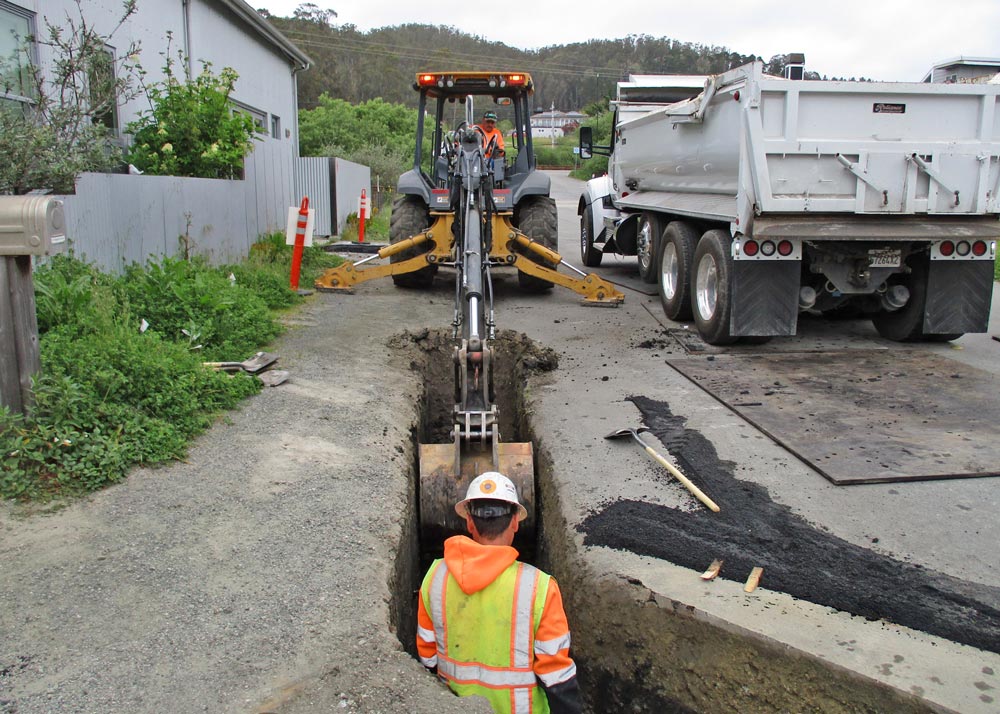

      Magellan/Highway 1 Portion of the Project

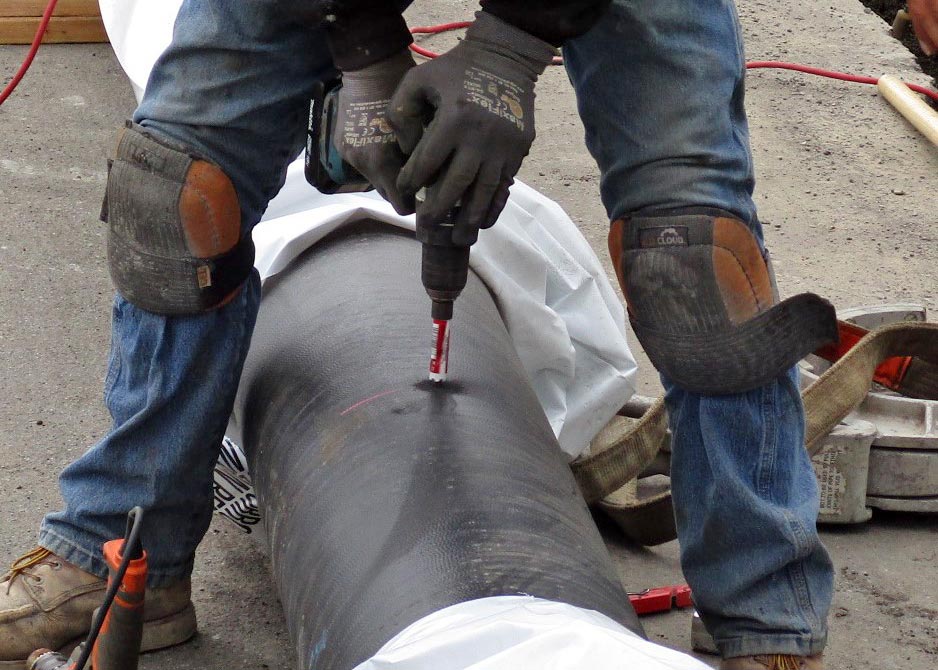

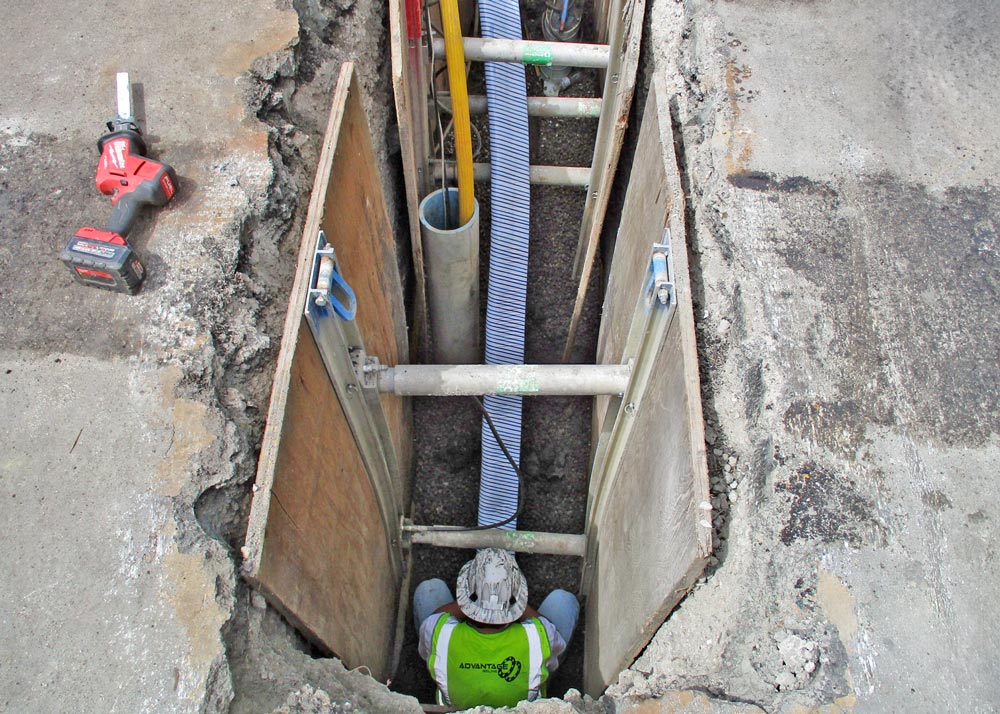

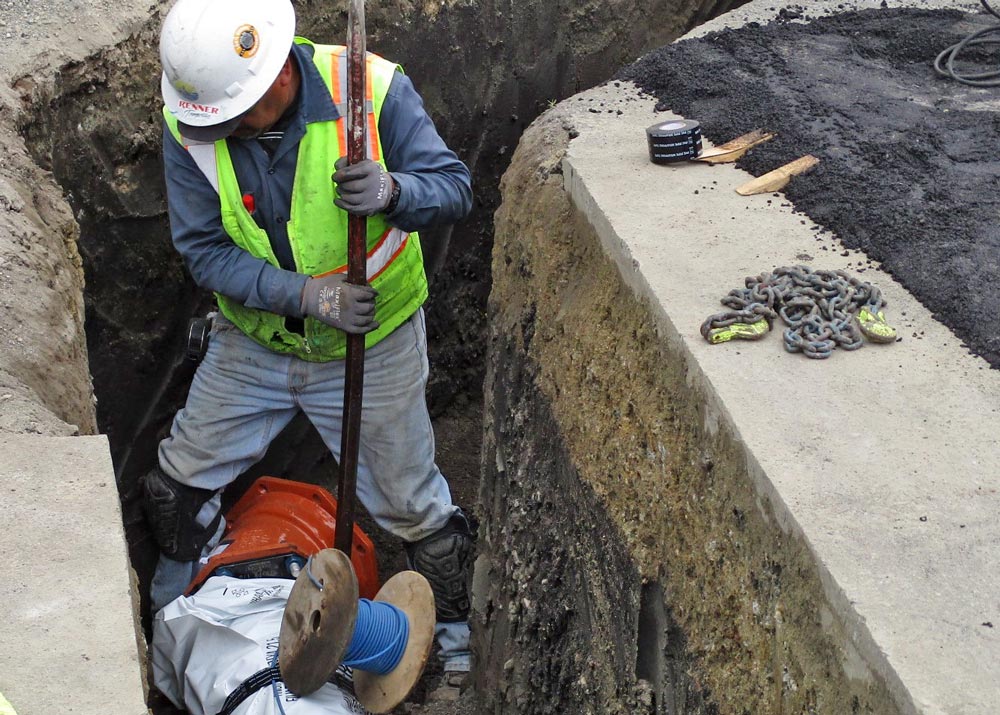

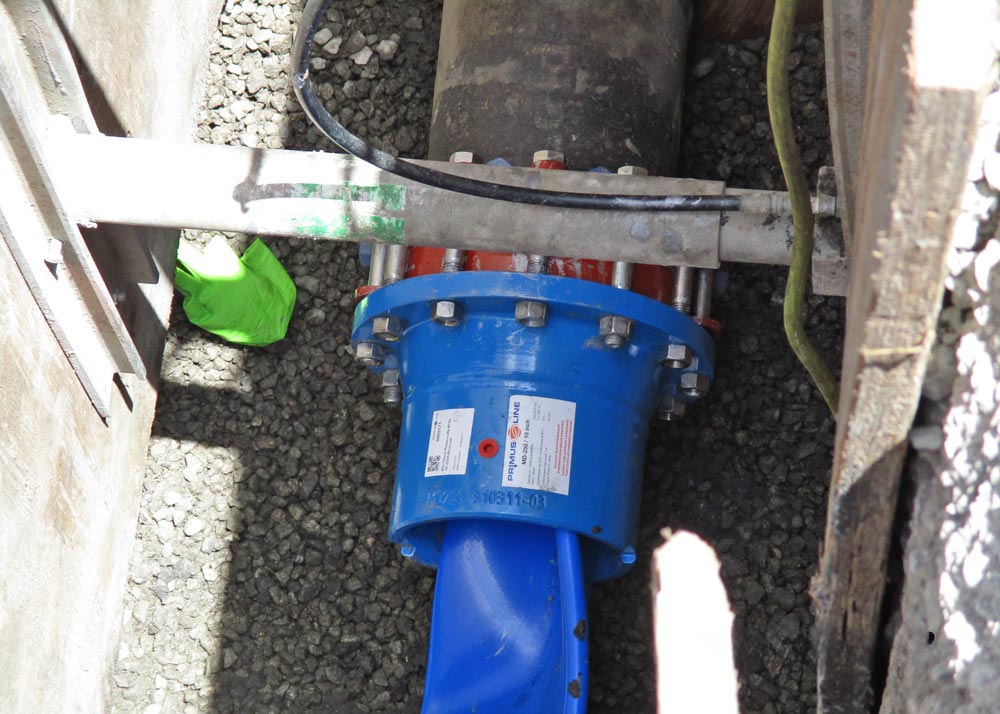

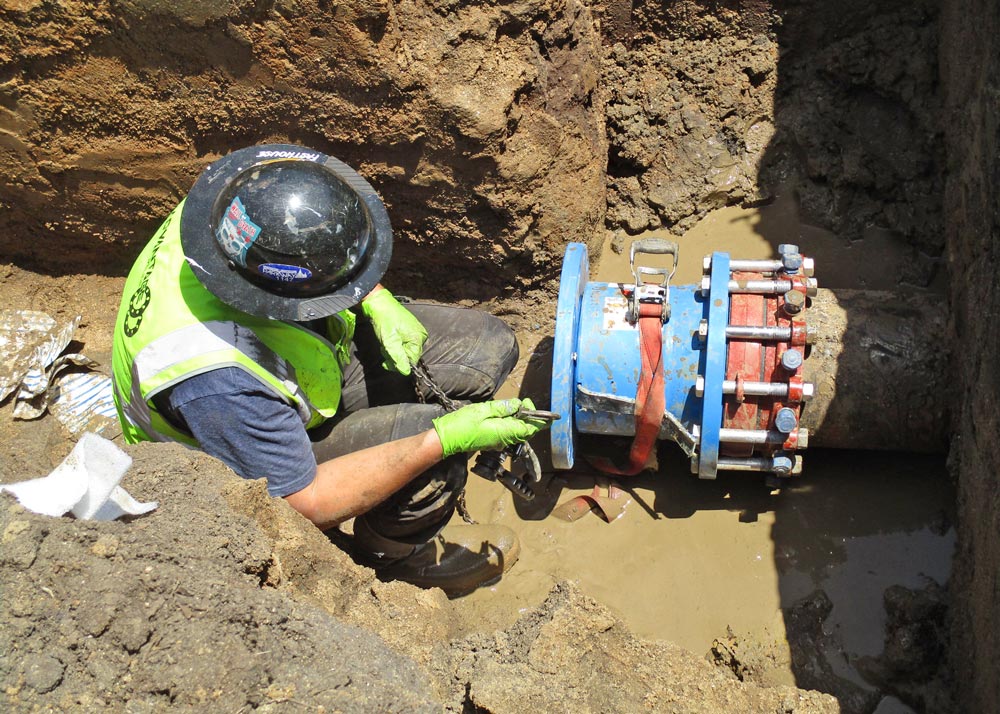

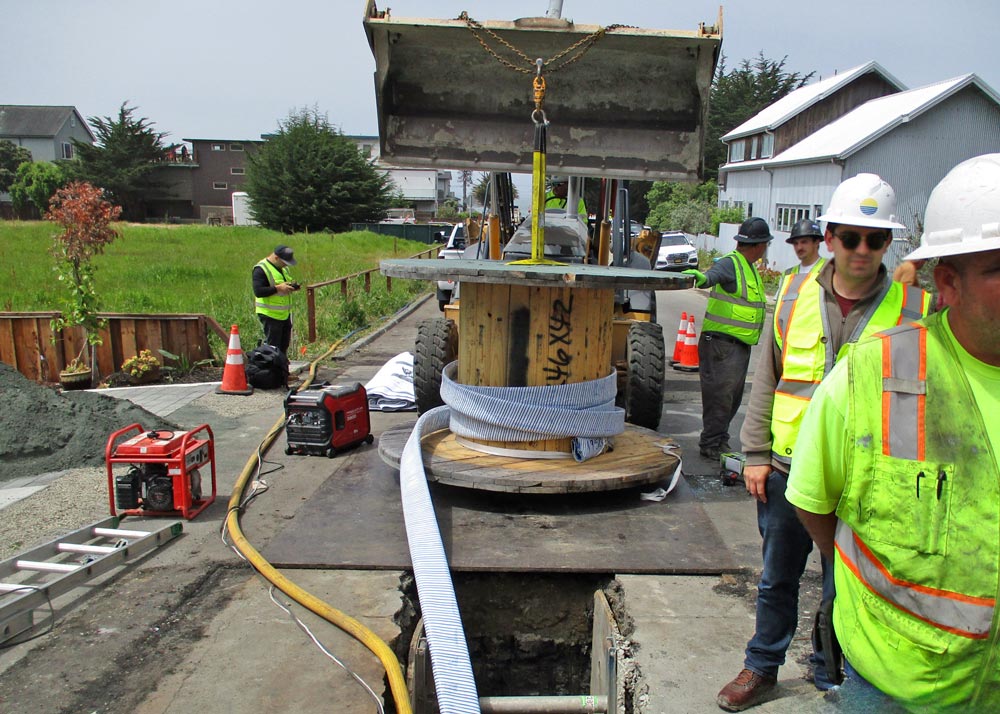

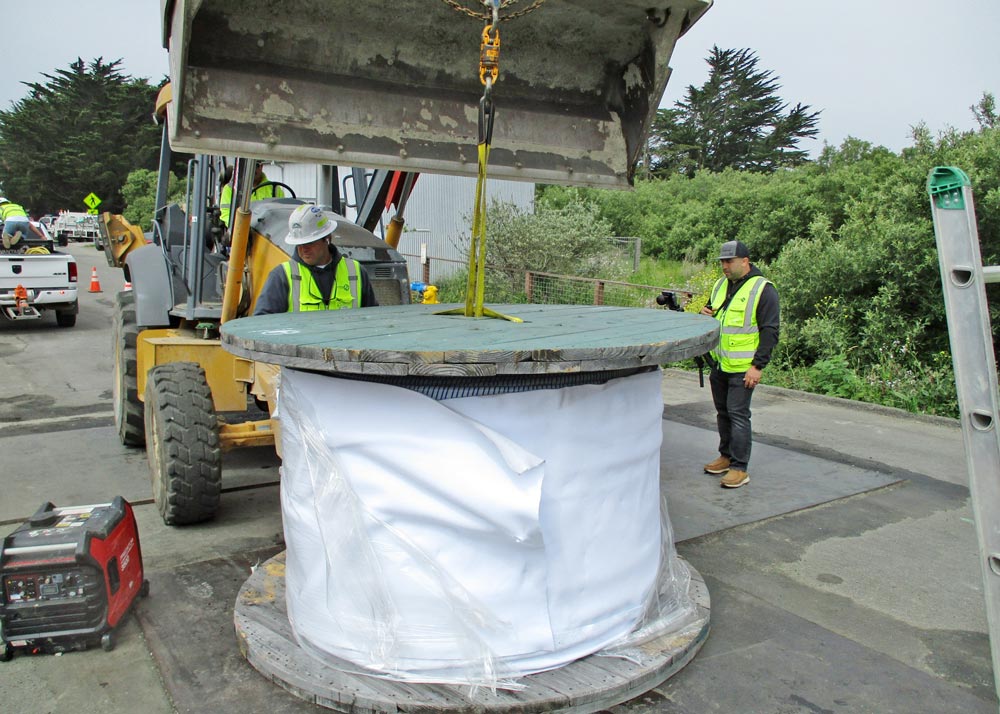

      Approximately 475 linear feet of existing 10-inch cast iron pipe was lined with Primus Line, a flexible fabric pipeline liner. This process was performed using the Primus slip lining technique, which avoided causing any disruptions on Highway 1 and the Coastal Trail, and saving the District $2M+ in pipeline replacement costs using traditional methods.

      Alameda Avenue Portion of the Project

      Around 175 linear feet of the existing 10-inch welded steel pipeline were lined with Primus Line, a flexible fabric pipeline liner.

      Completed June of 2024

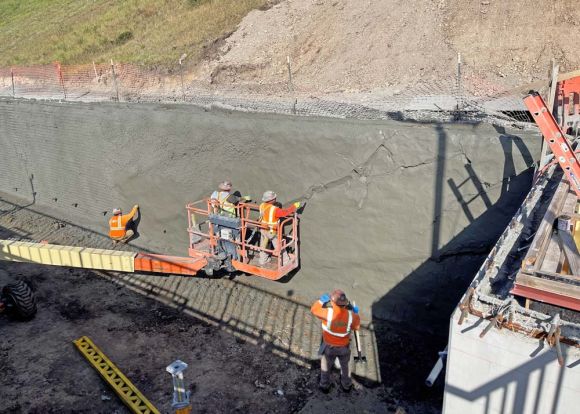

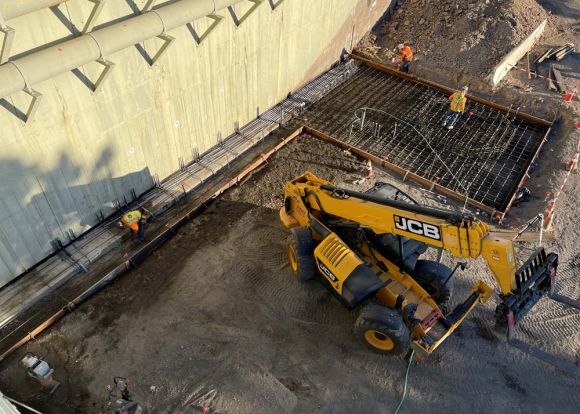

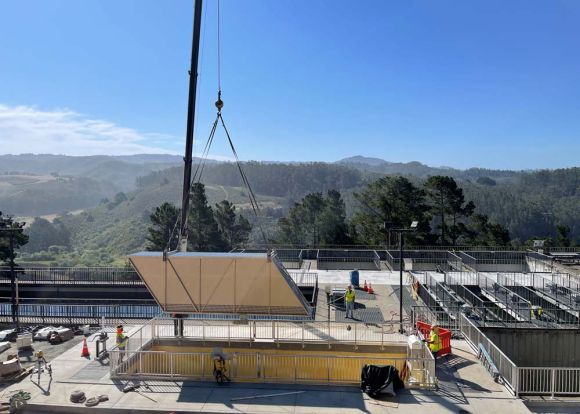

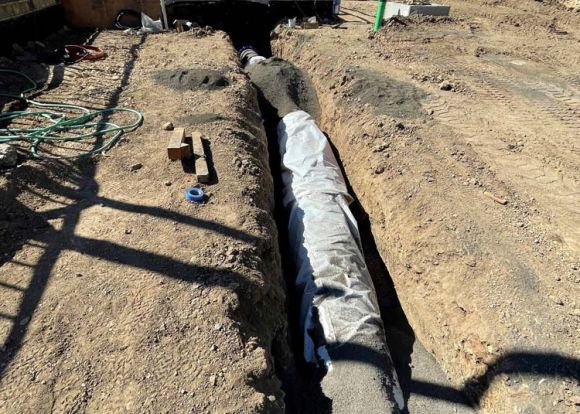

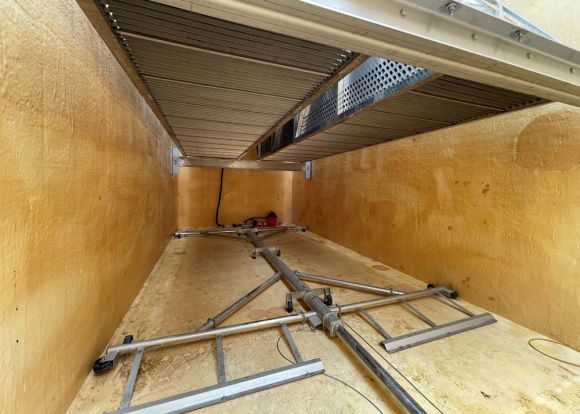

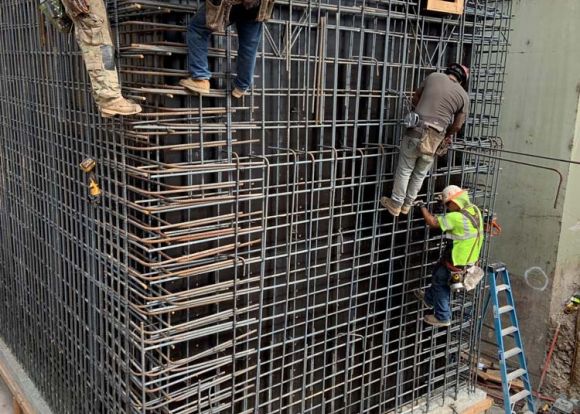

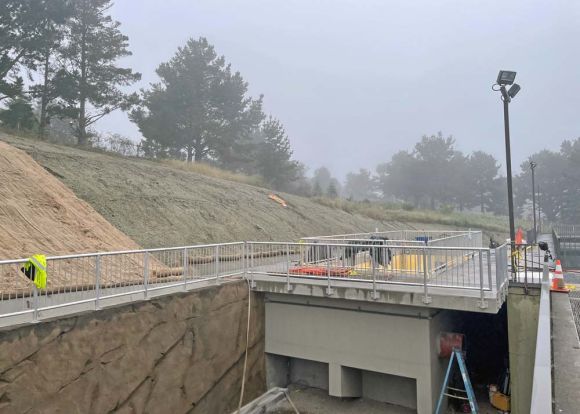

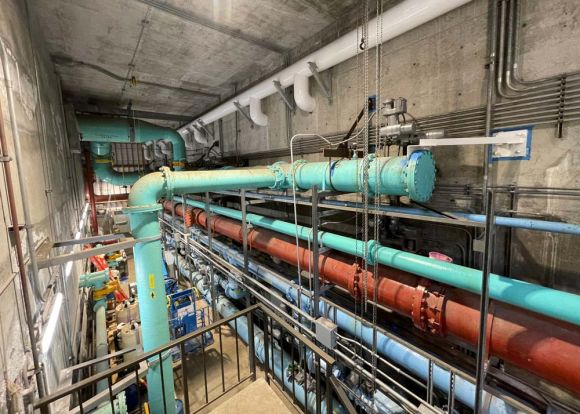

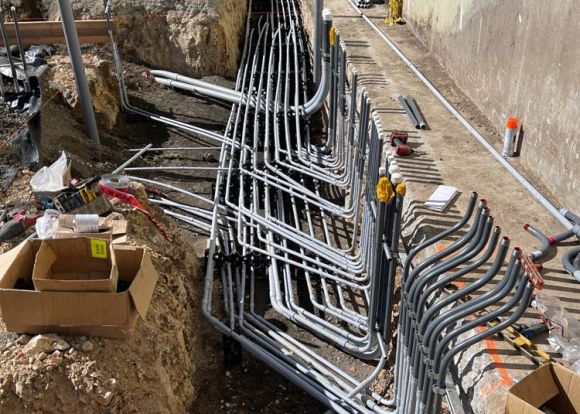

      Nunes Water Treatment Plant Improvement Project

      Project Cost: $10,450,000
      LEARN MORE

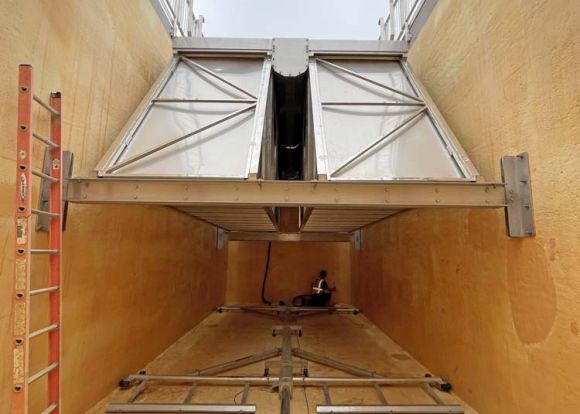

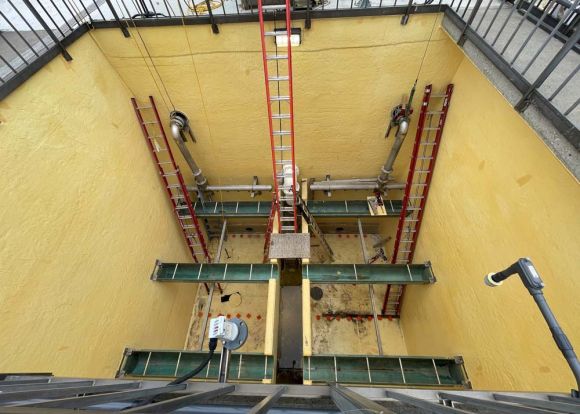

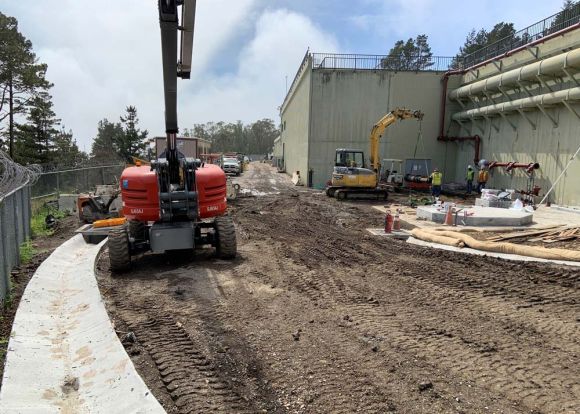

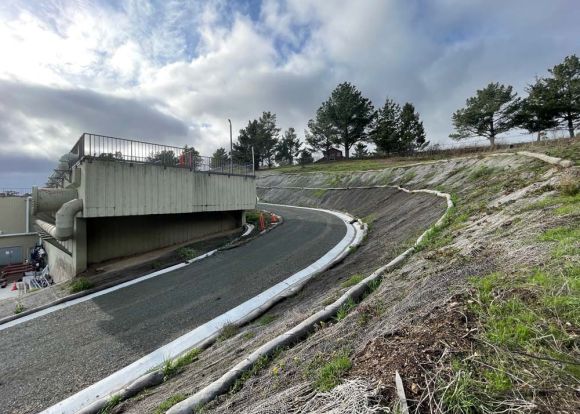

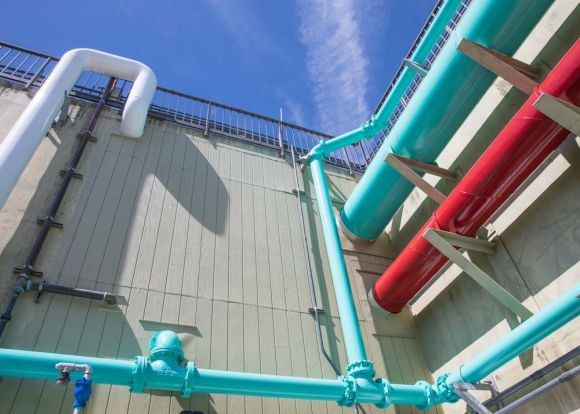

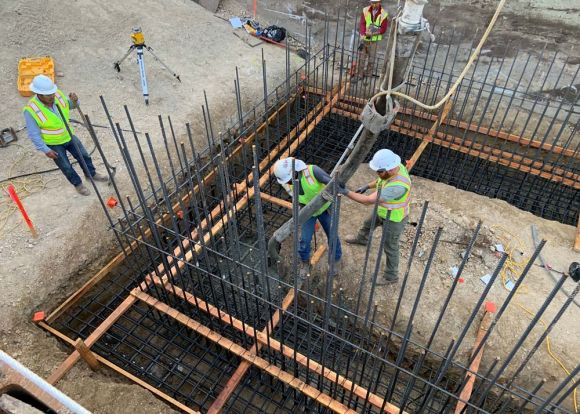

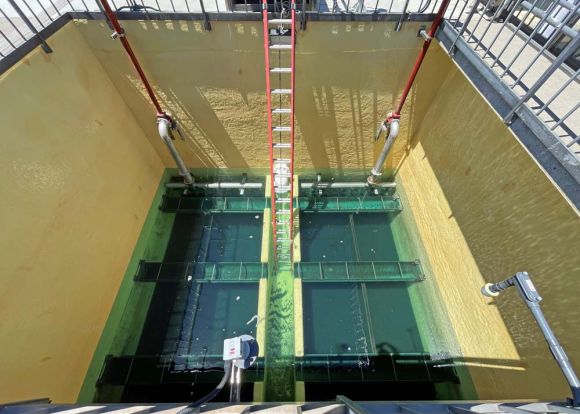

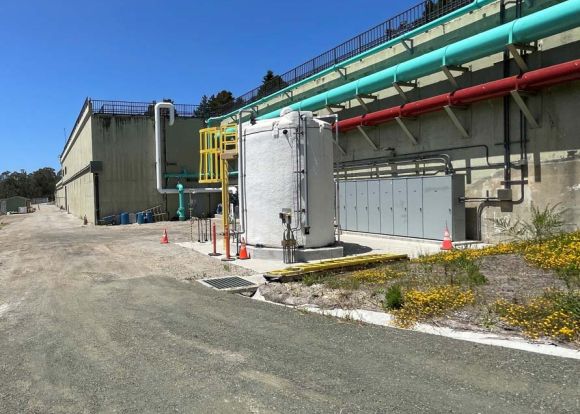

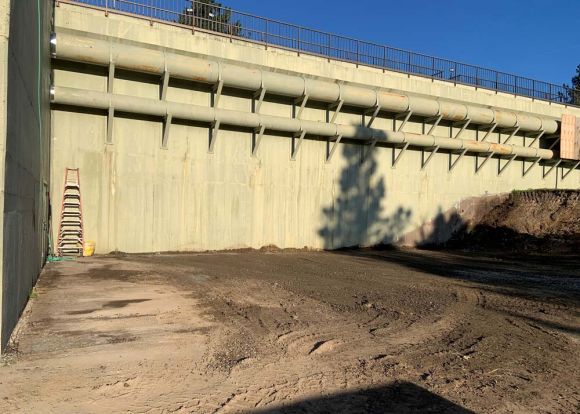

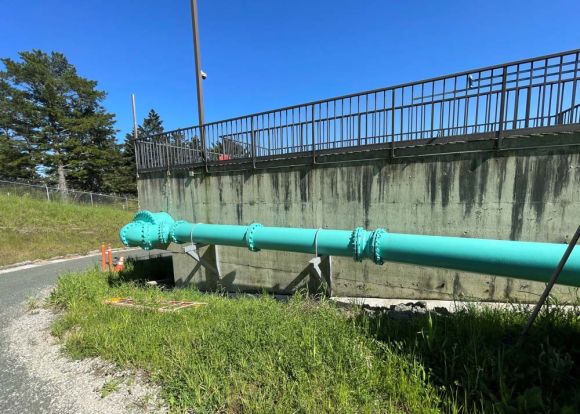

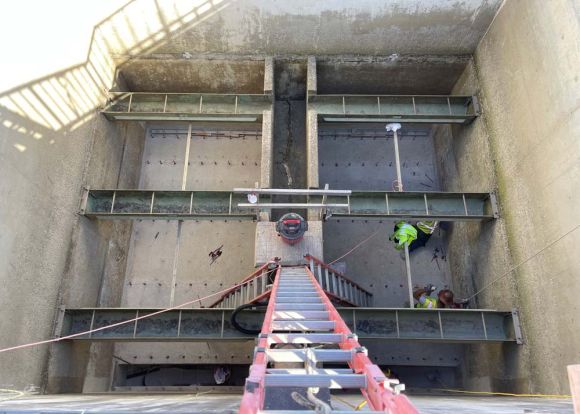

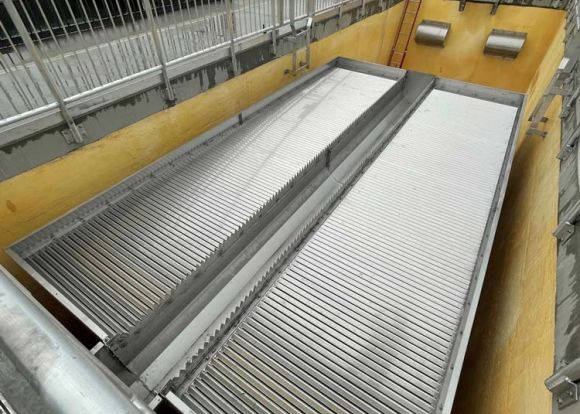

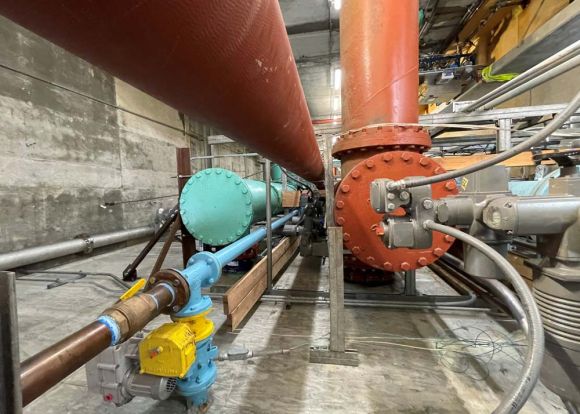

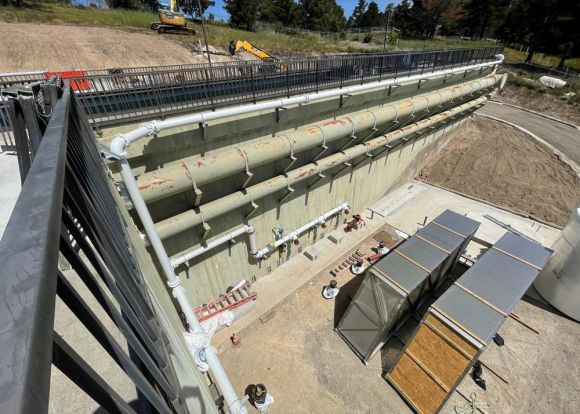

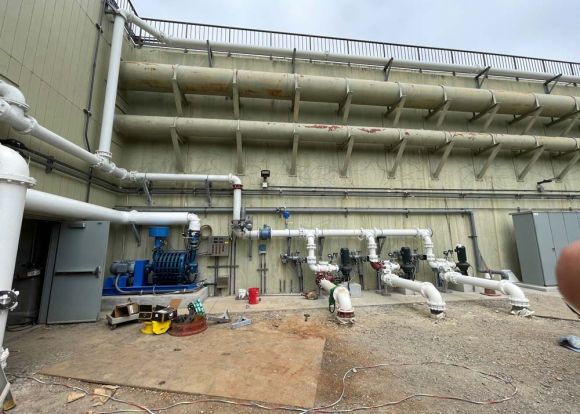

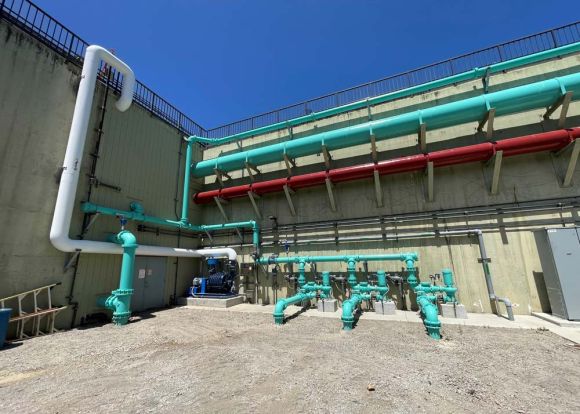

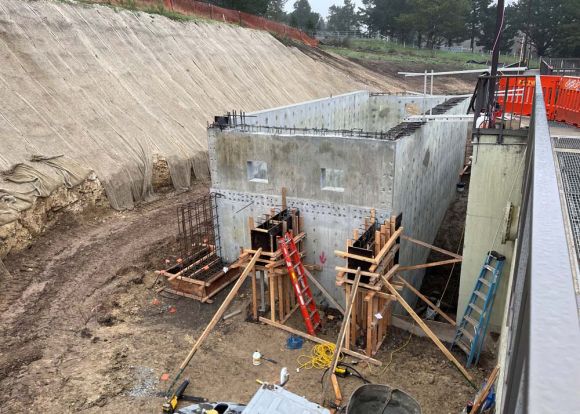

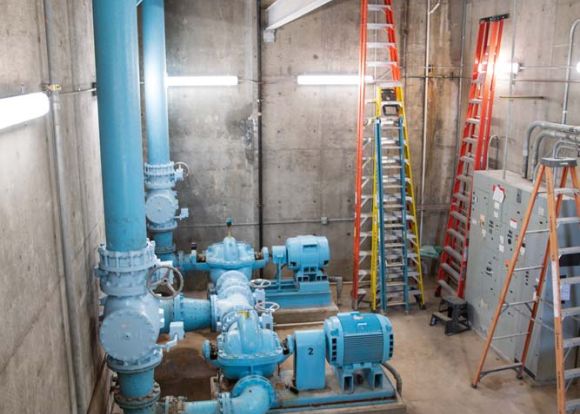

      The District has completed upgrades to its Nunes Water Treatment Plant in Half Moon Bay, California. There were numerous improvements made during the 3 years, which included the following main items of work: a new plate settler sedimentation basin, a new caustic soda storage tank, site improvements, filter improvements, clearwell improvements, and electrical/instrumentation improvements. These upgrades provide operational redundancy and efficiency at the treatment plant, so that it has backups in case of equipment failure, allowing for quick restoration of normal operations without significant disruptions to water service.

      Staff Report – July 5th, 2024 – Board Meeting (PDF)

      “We invested a lot of money, but we got an enormous bang for the buck.”

      Director Glenn Reynolds

      Completed June of 2024

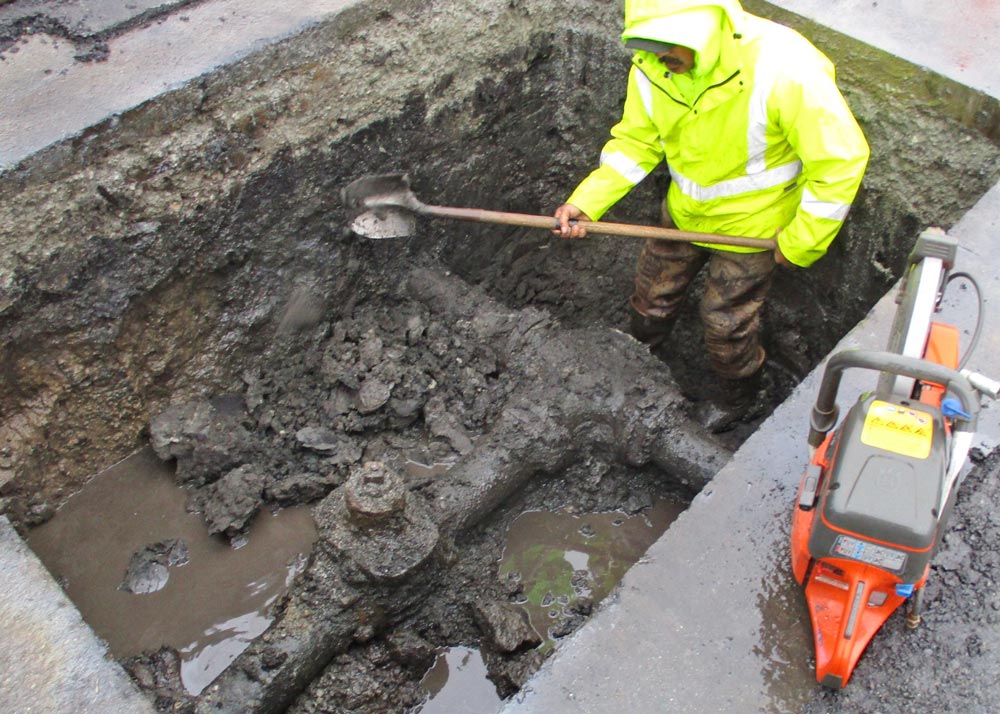

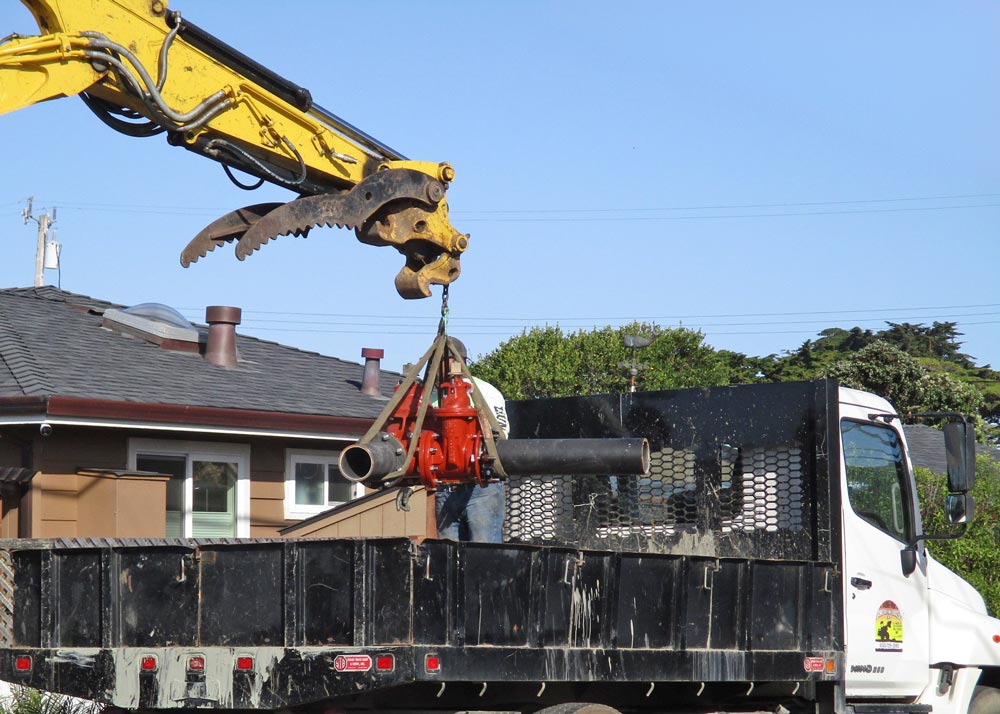

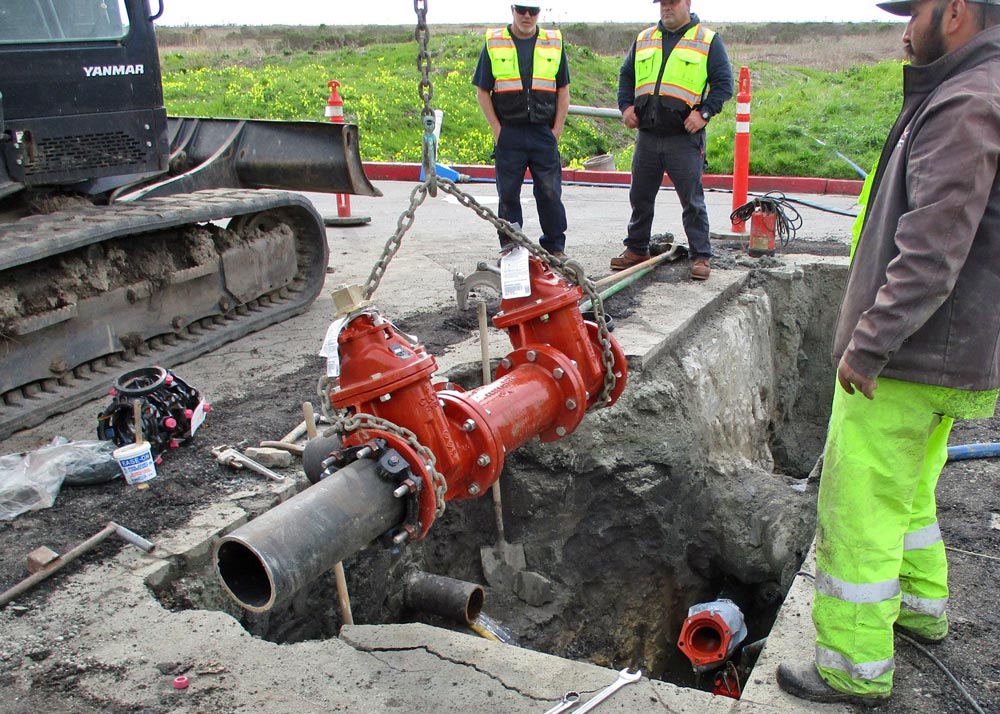

      Valve Replacement Project

      Project Cost: $300,000
      LEARN MORE

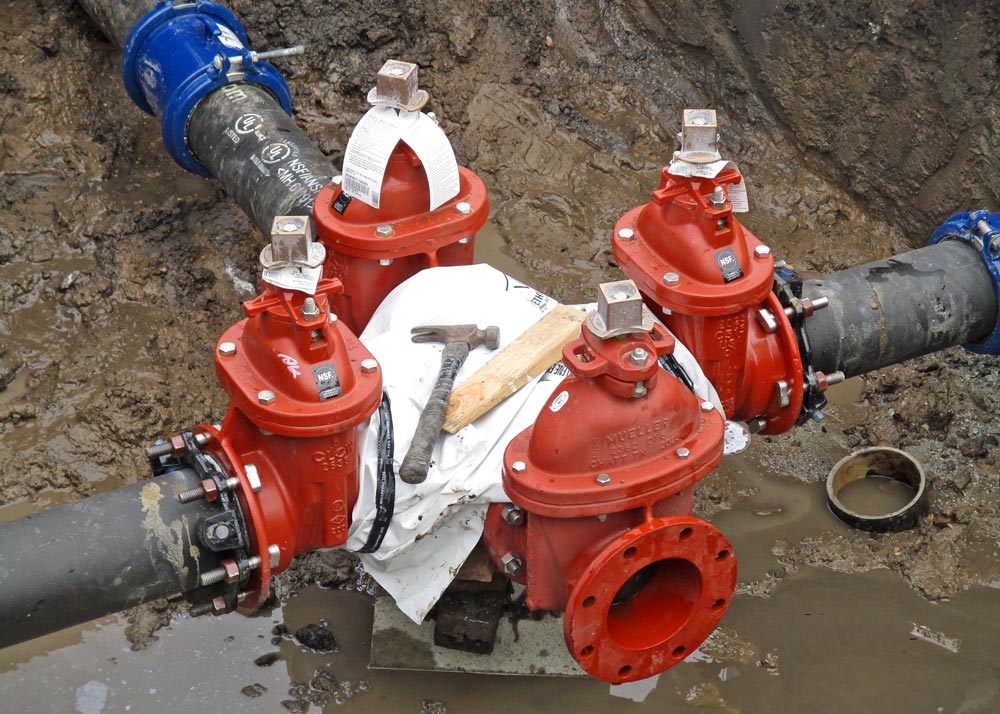

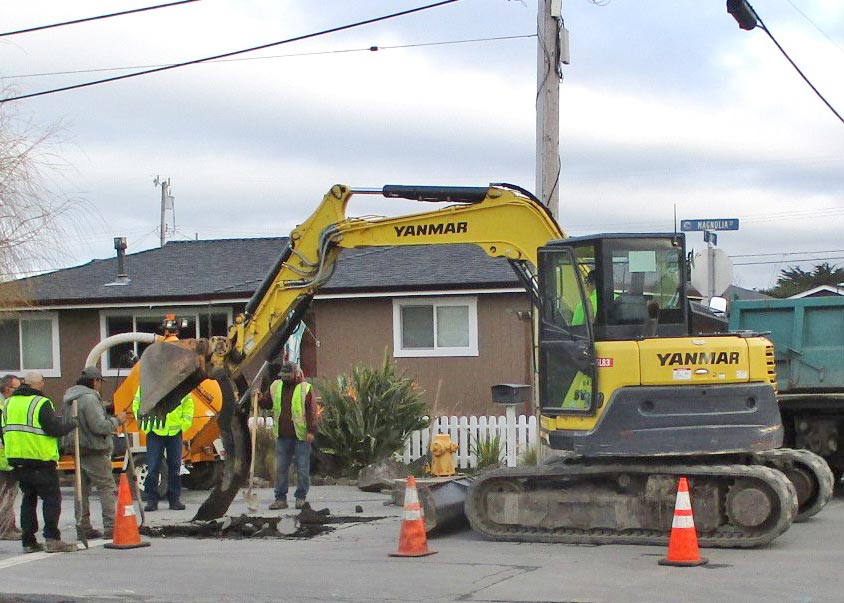

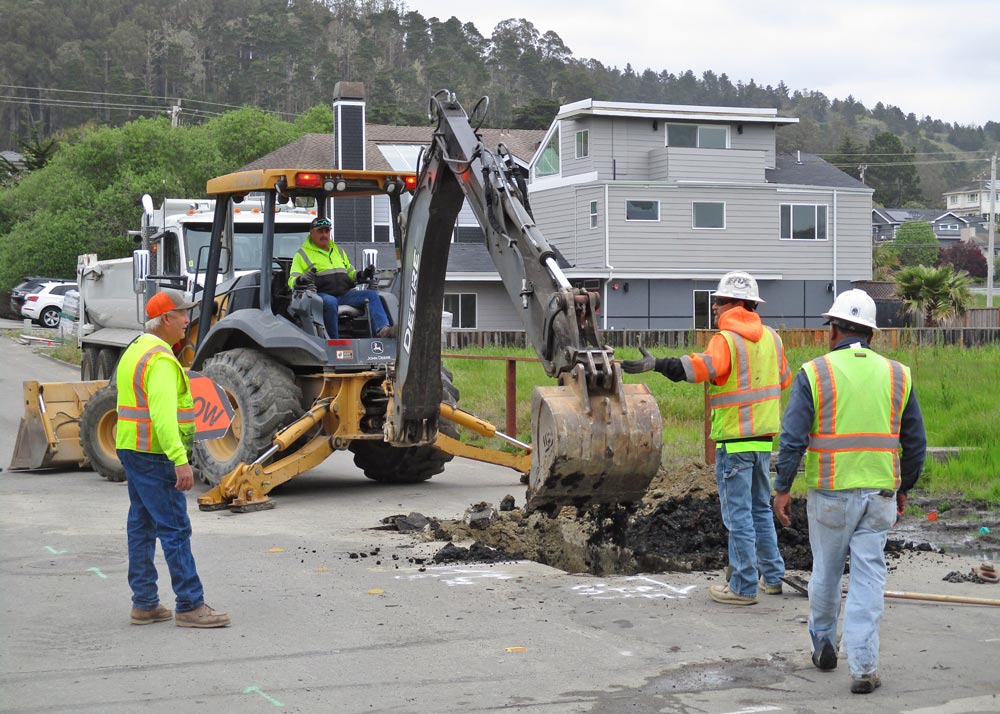

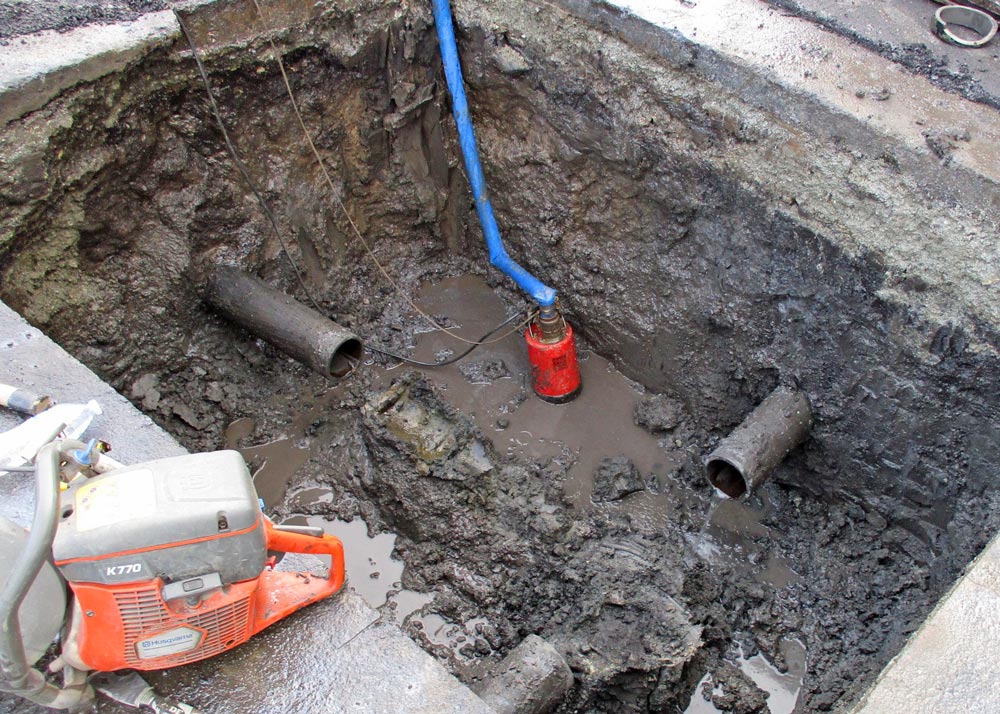

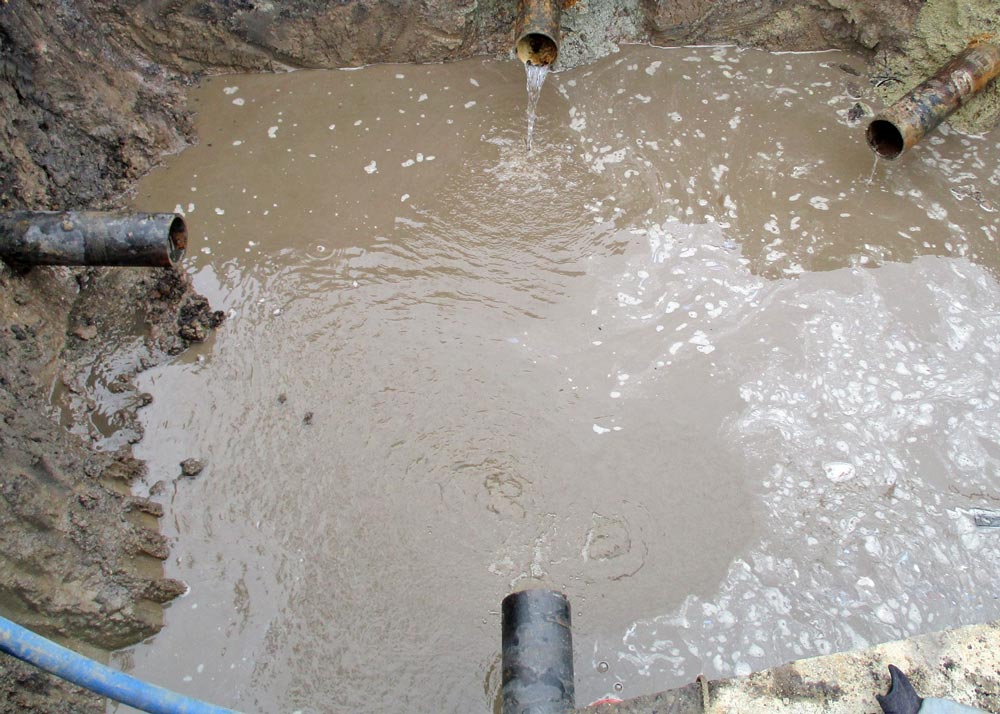

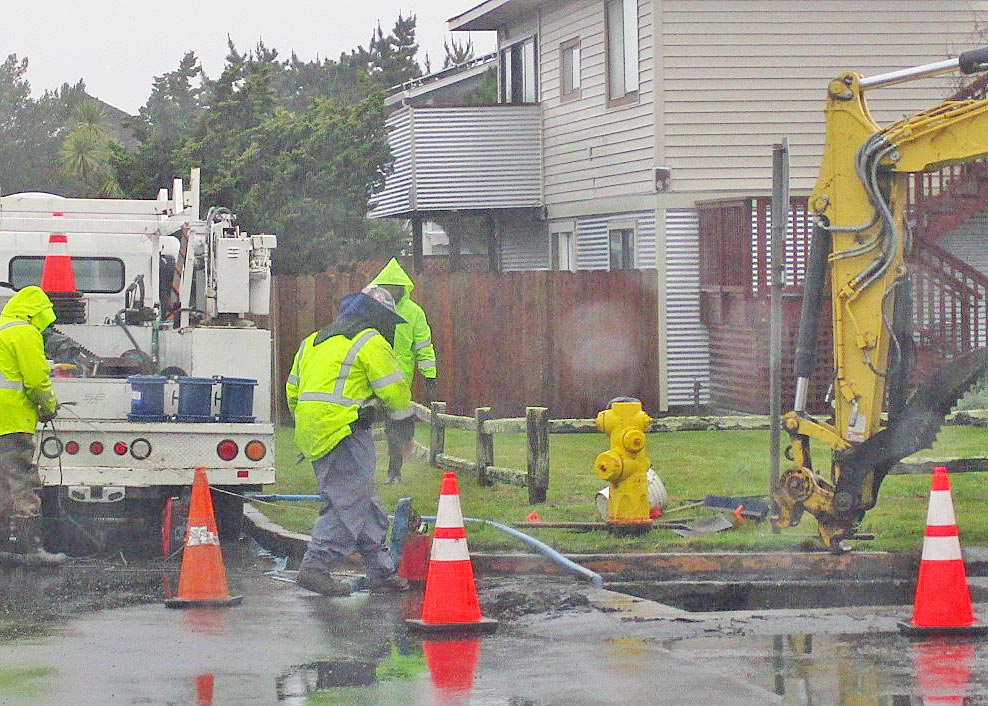

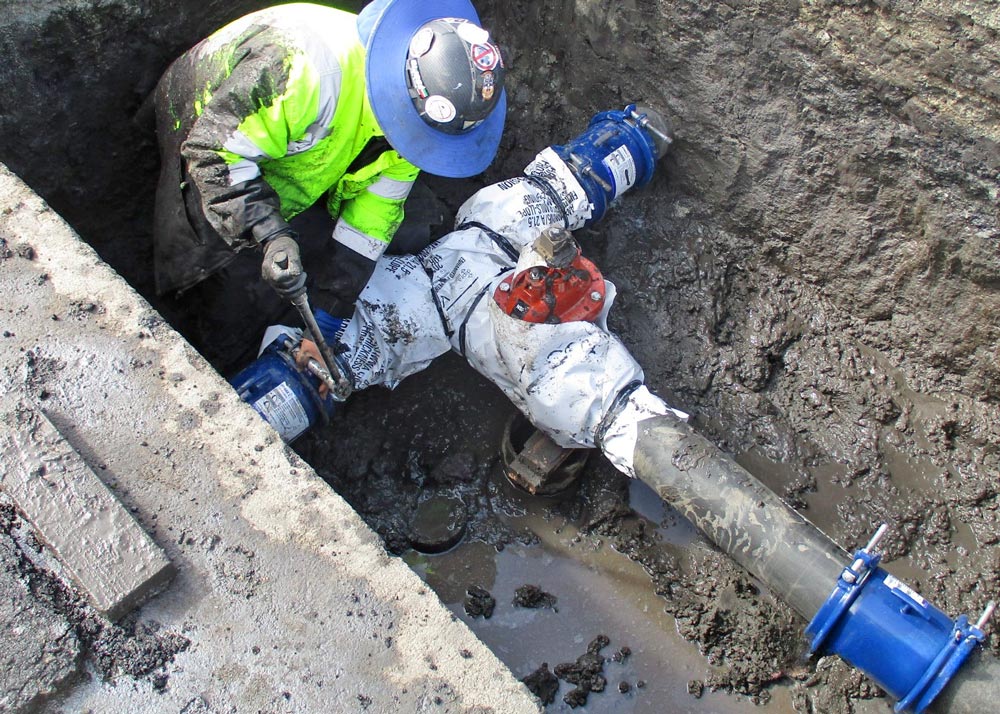

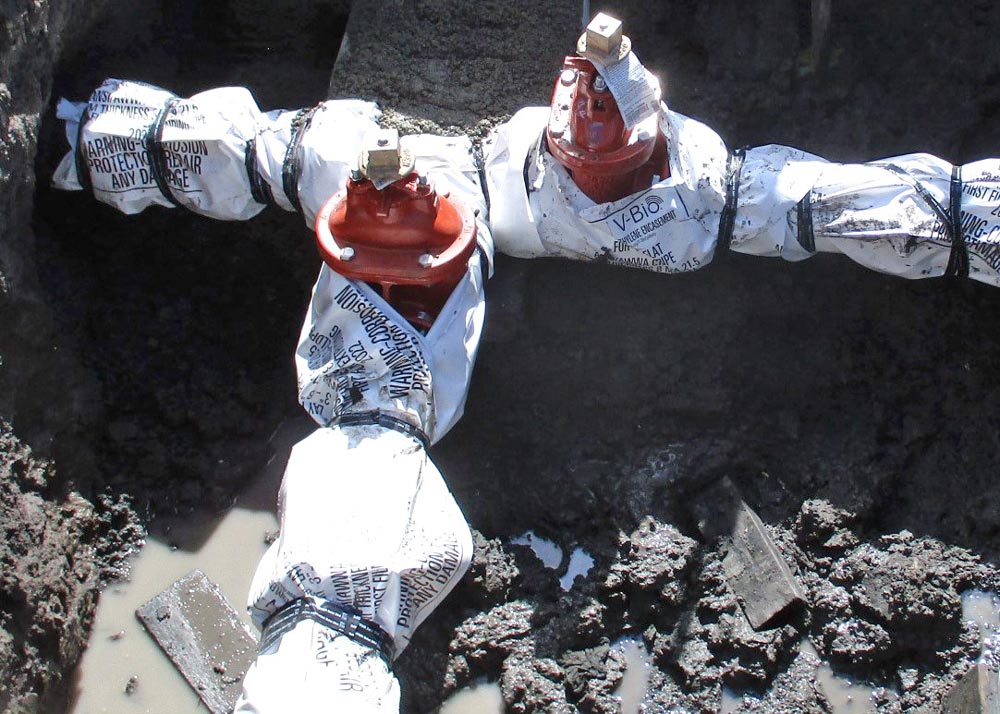

      This project involved replacing 15 water main valves in disrepair, removal of a 6″ water main that crossed behind several backyards along 2nd Avenue (between Granelli Avenue and Myrtle Street), and installation and connection of approximately 50 linear feet of new 6″ ductile iron pipe water mains.

      Completed February of 2024

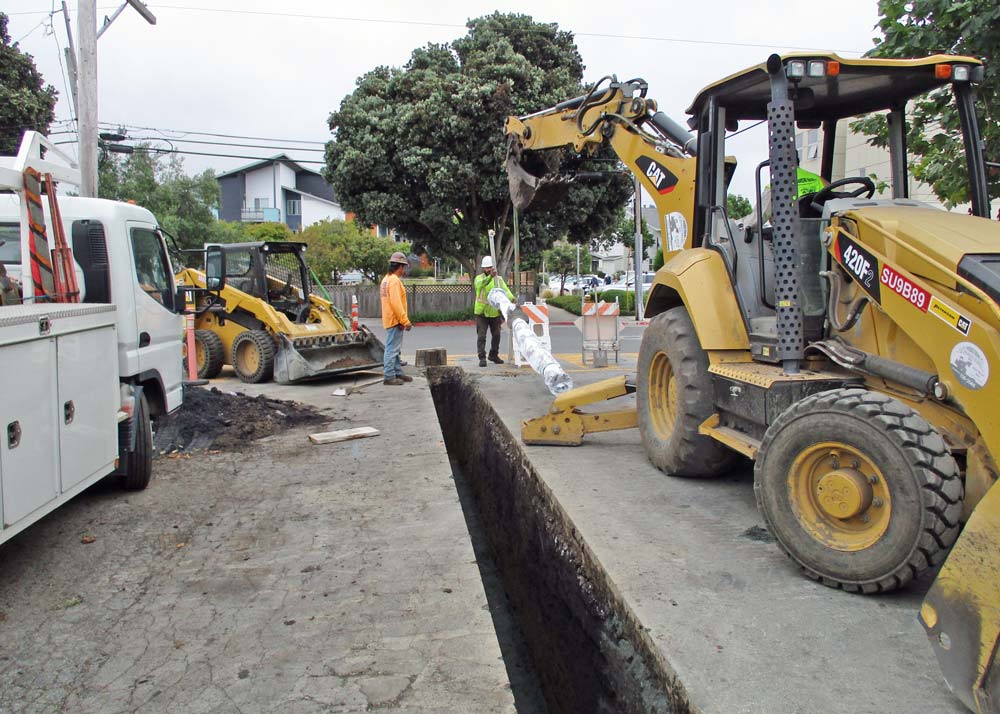

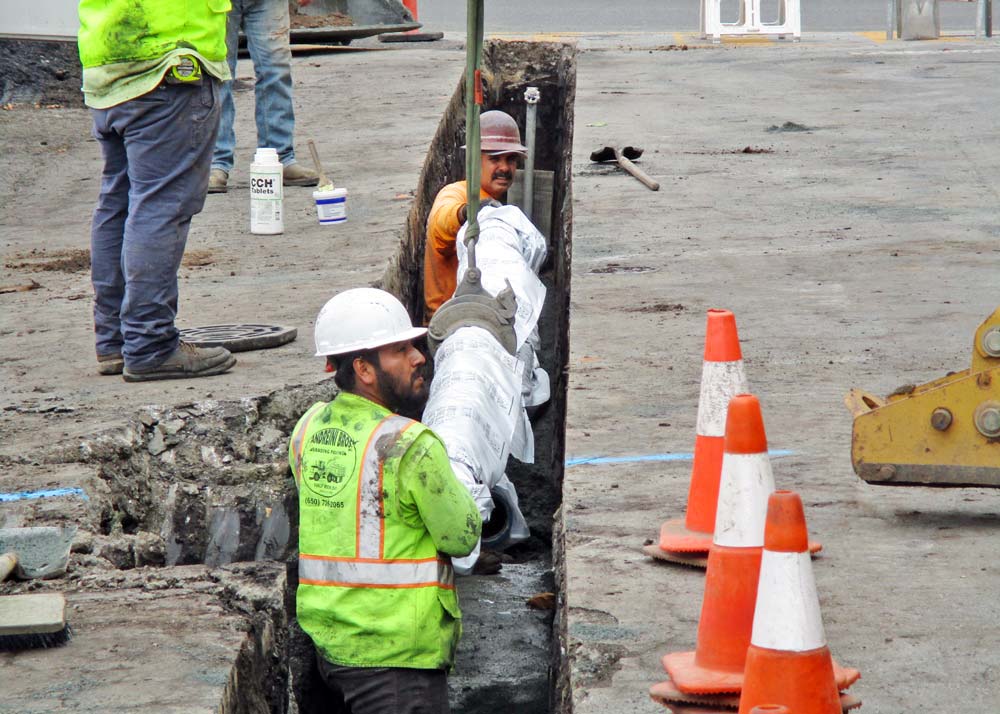

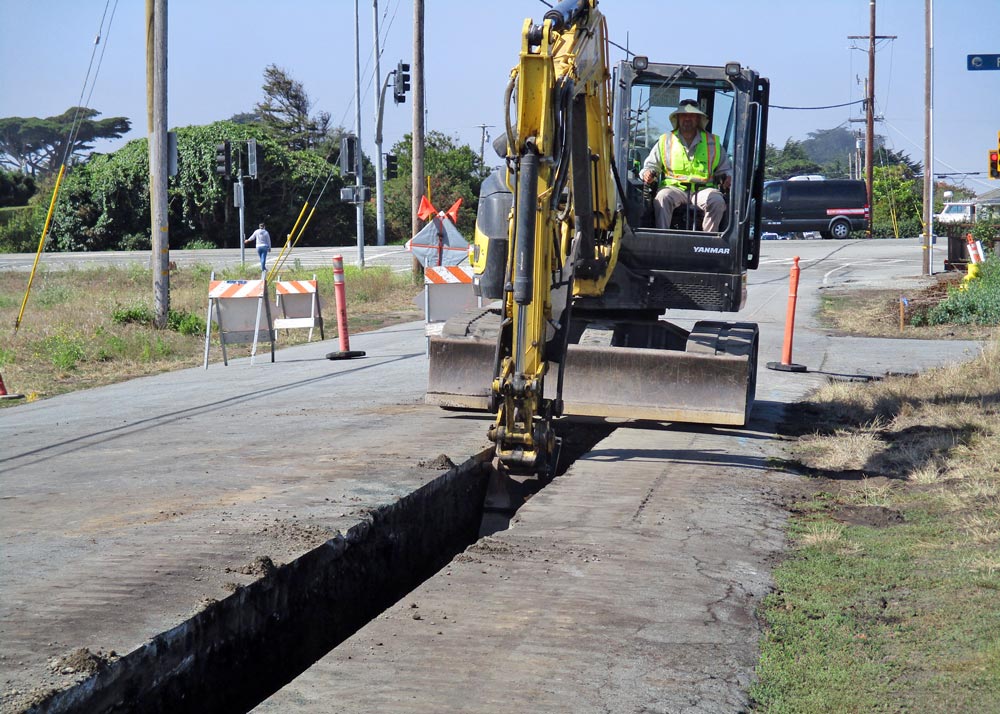

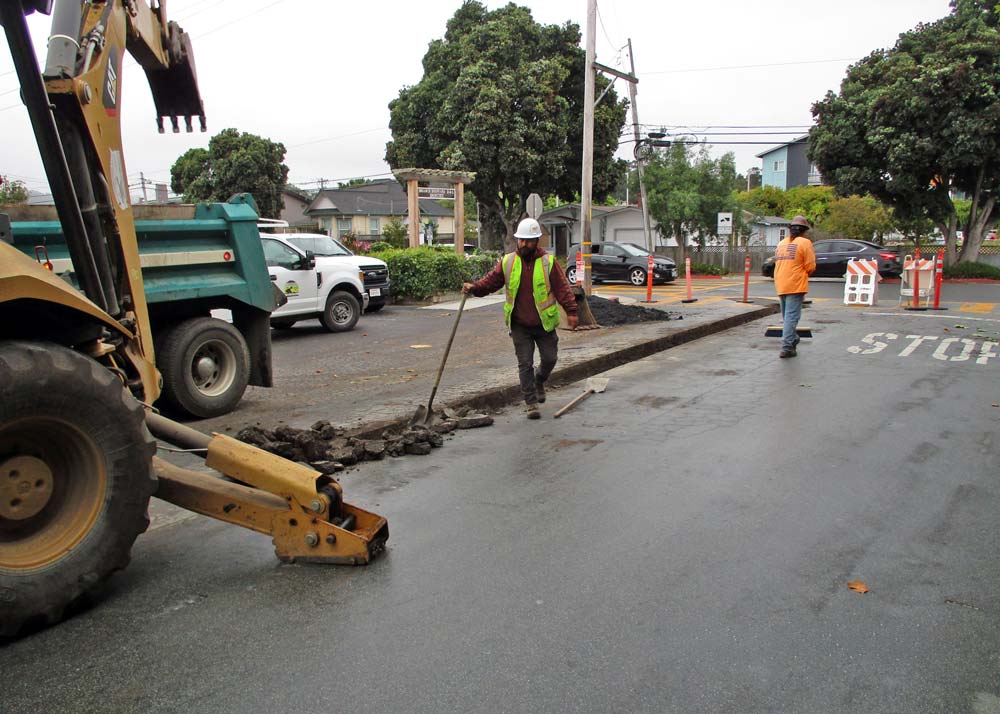

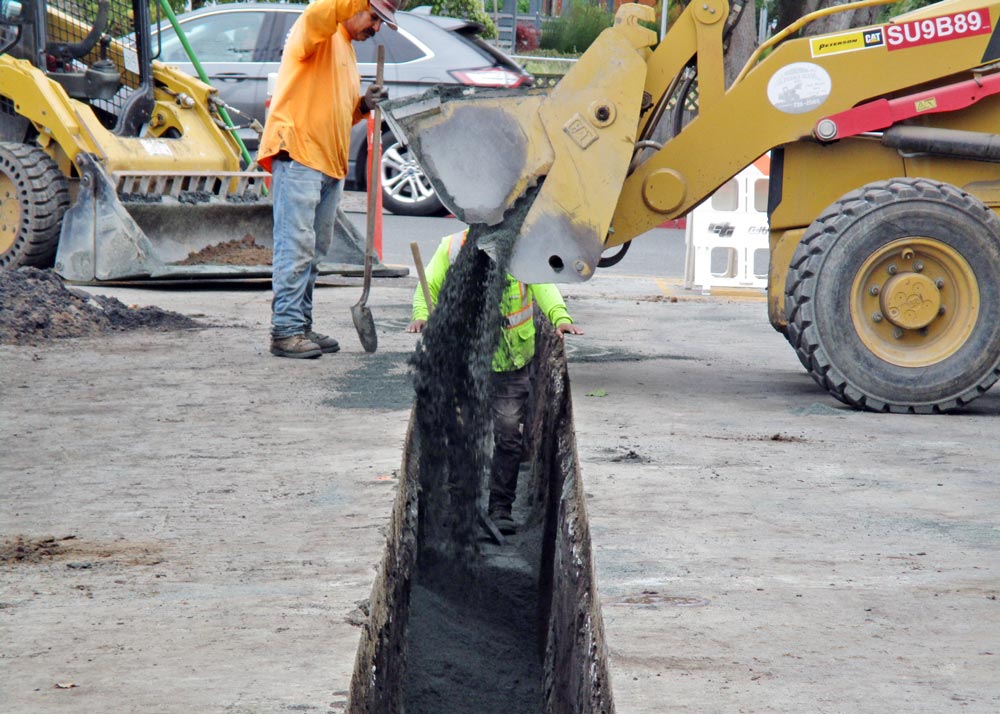

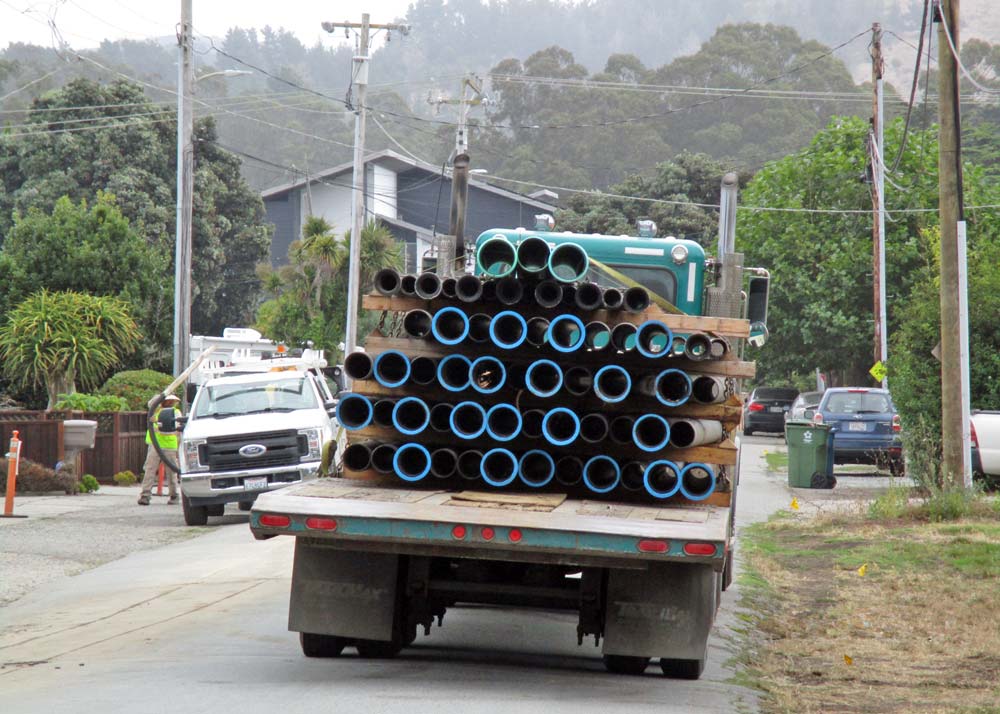

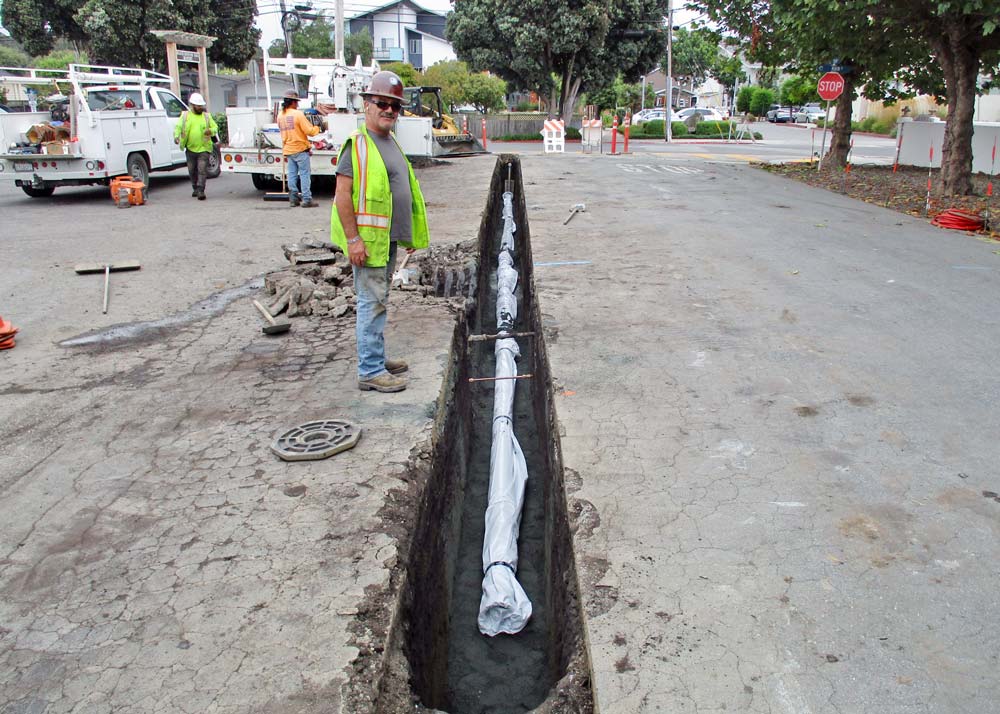

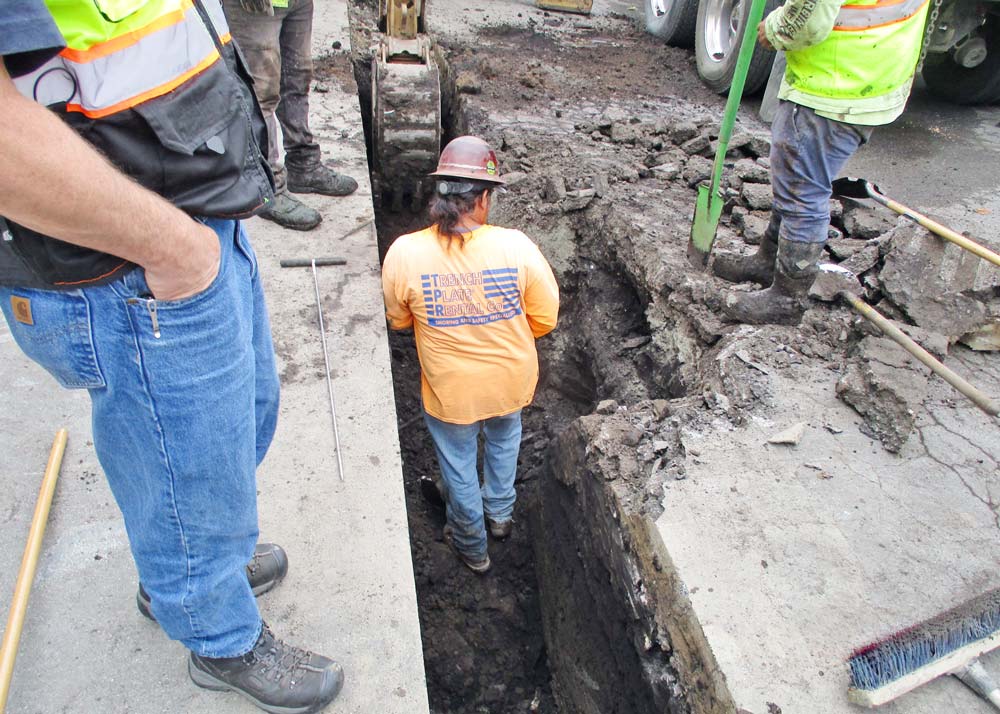

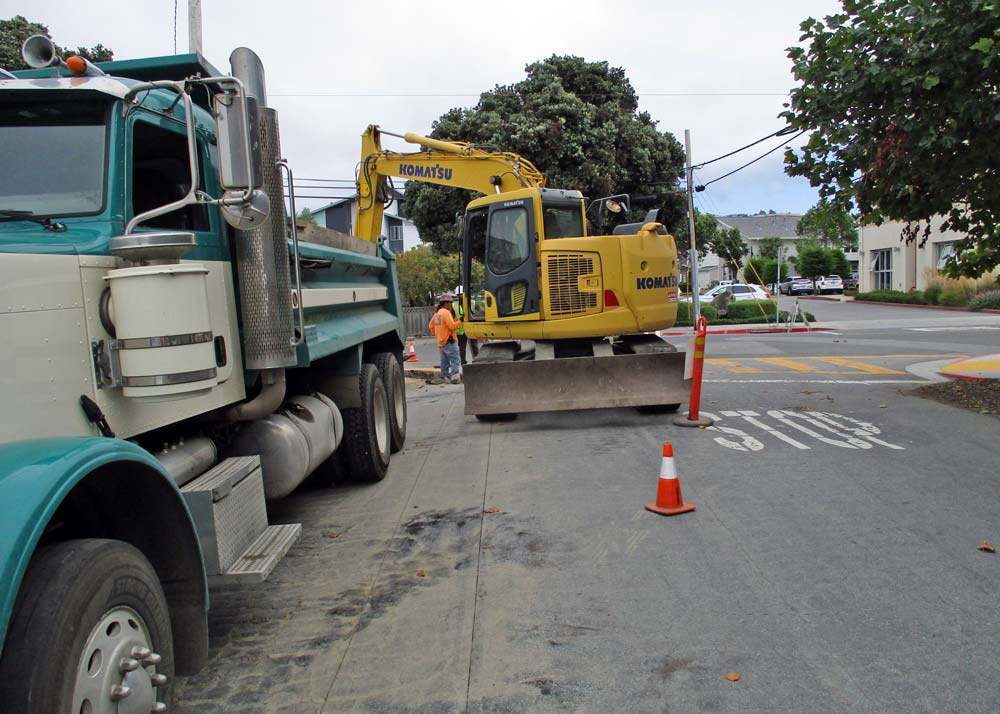

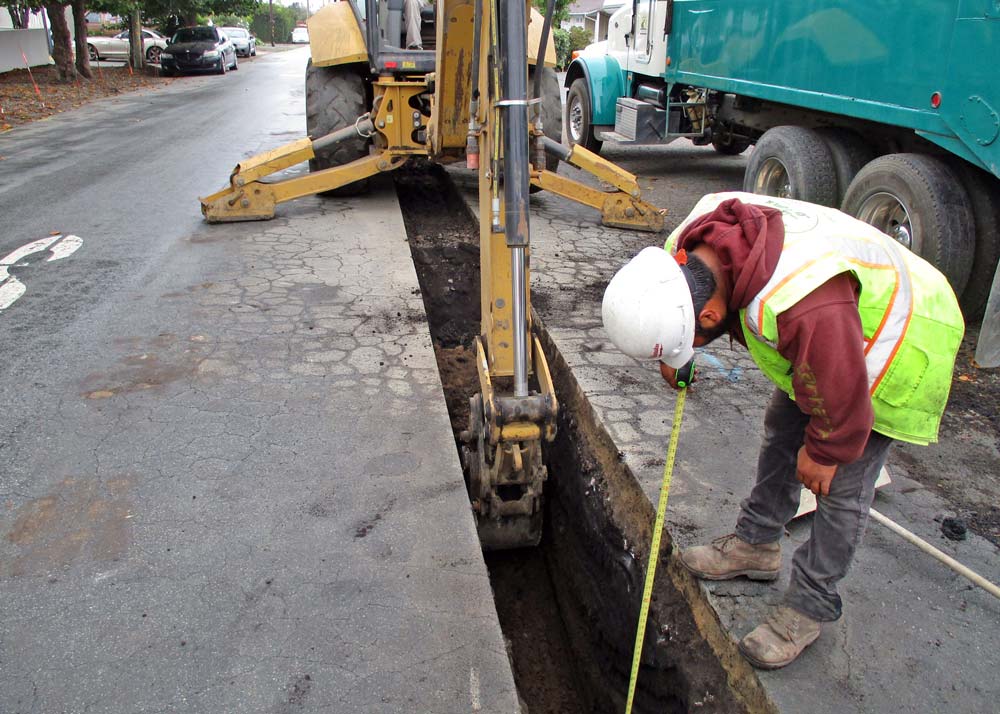

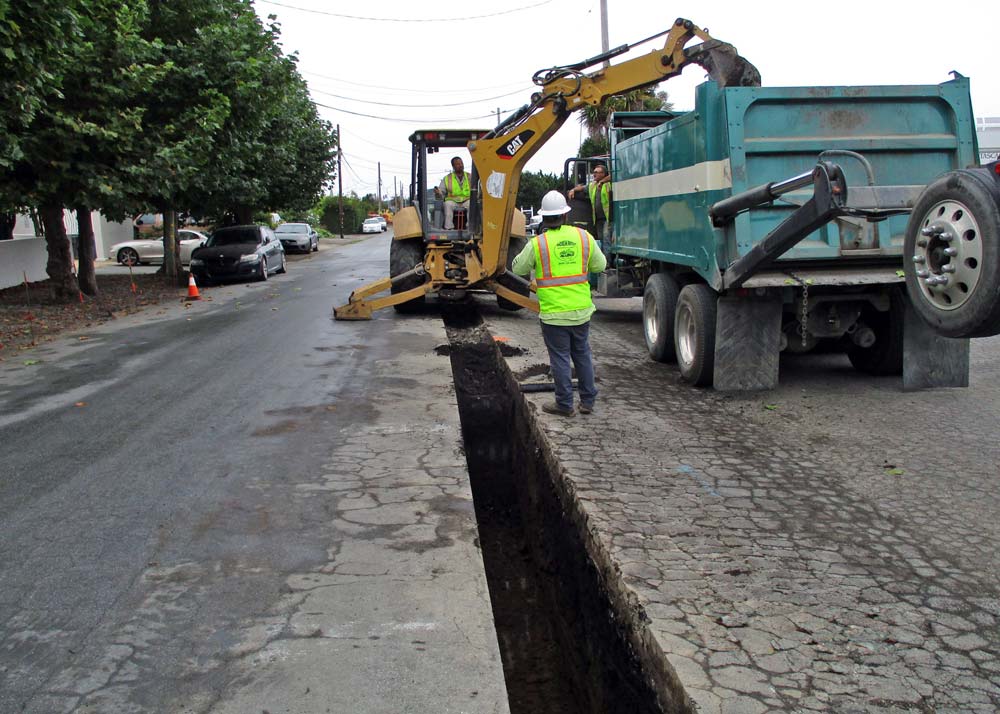

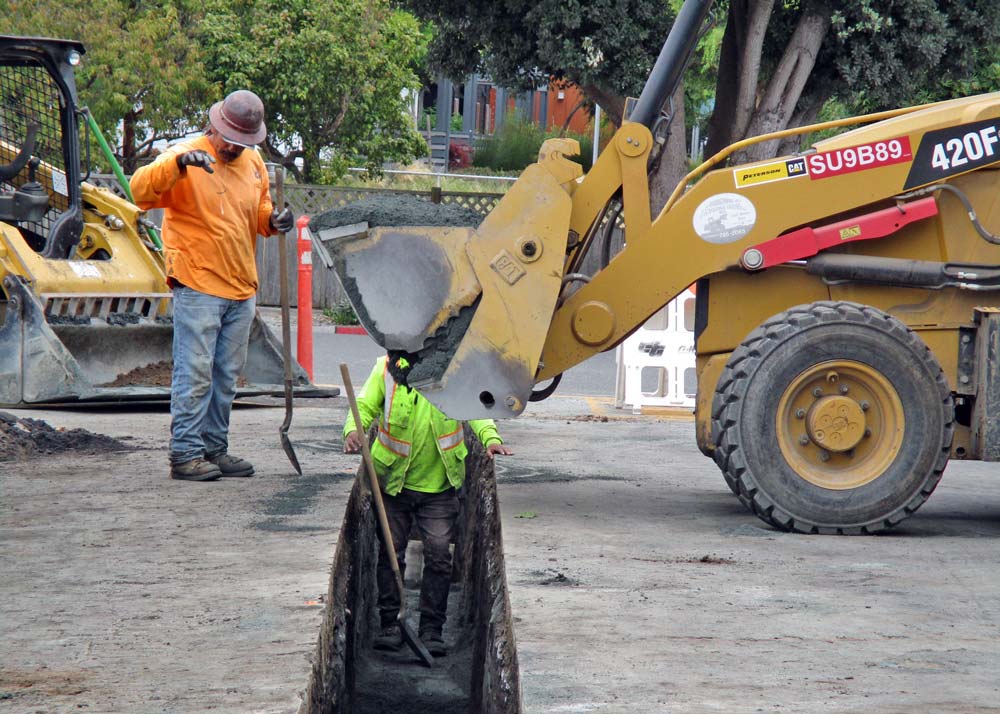

      Poplar Street Water Main Replacement Project

      Project Cost: $416,000
      LEARN MORE

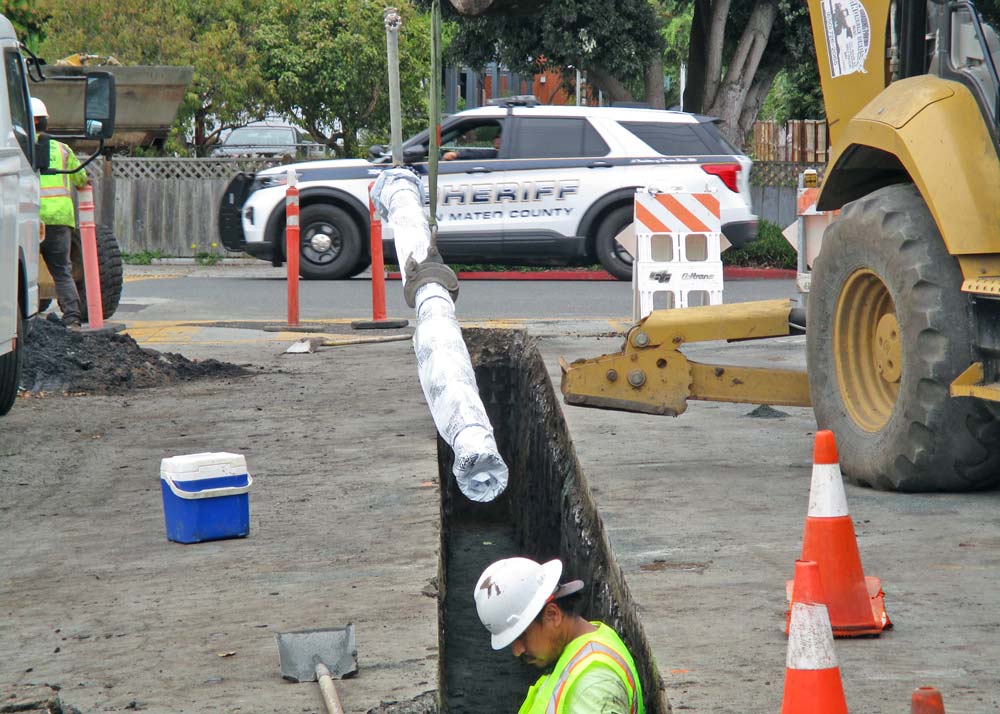

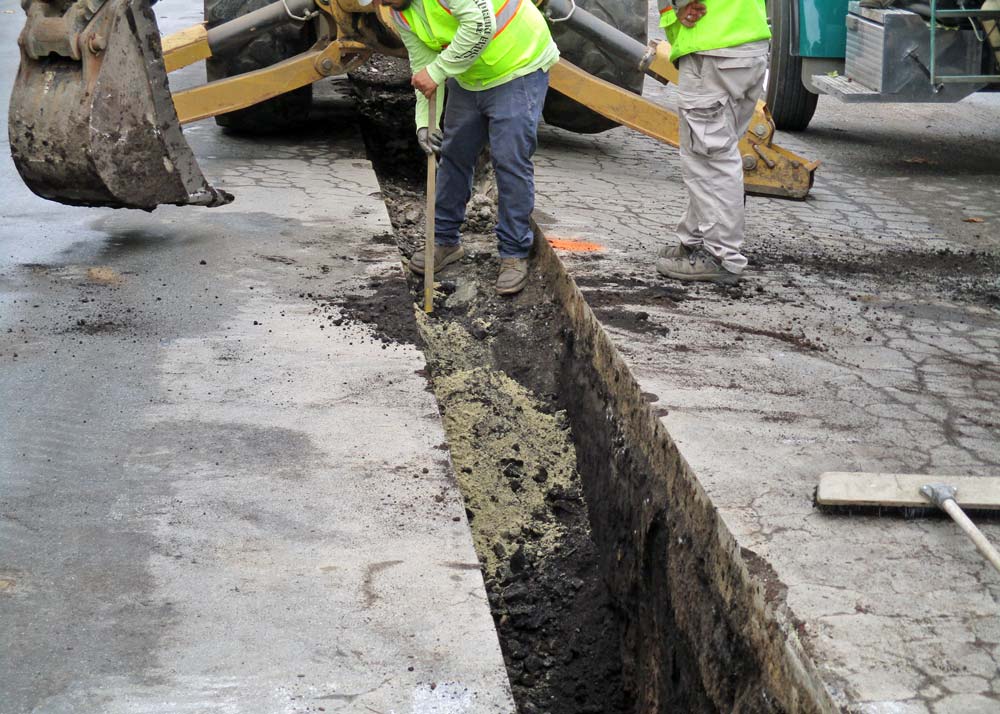

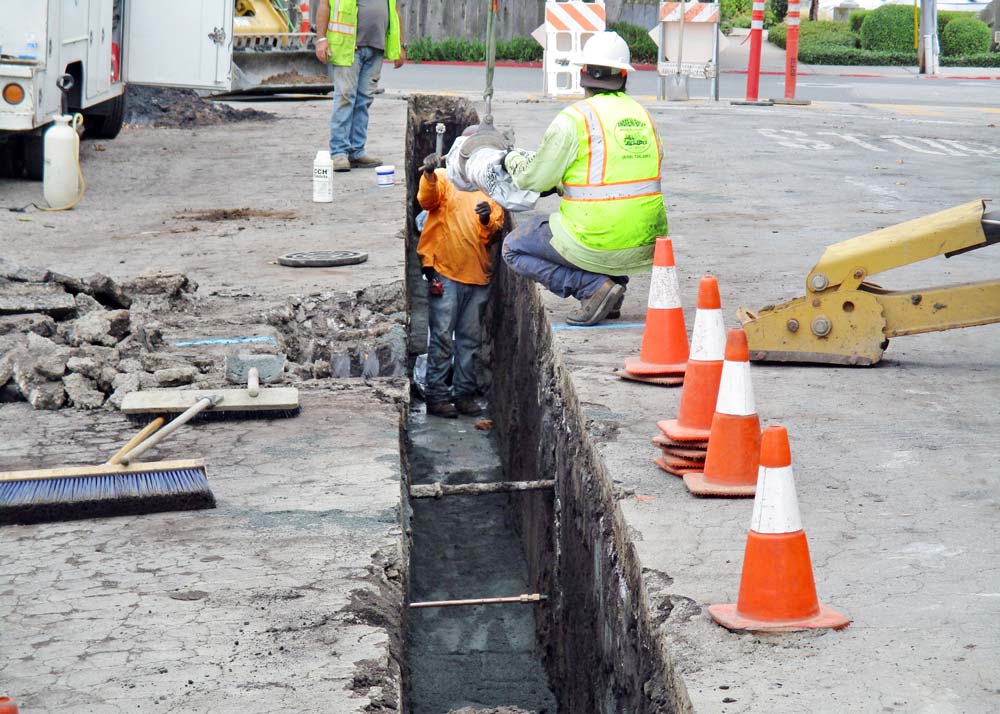

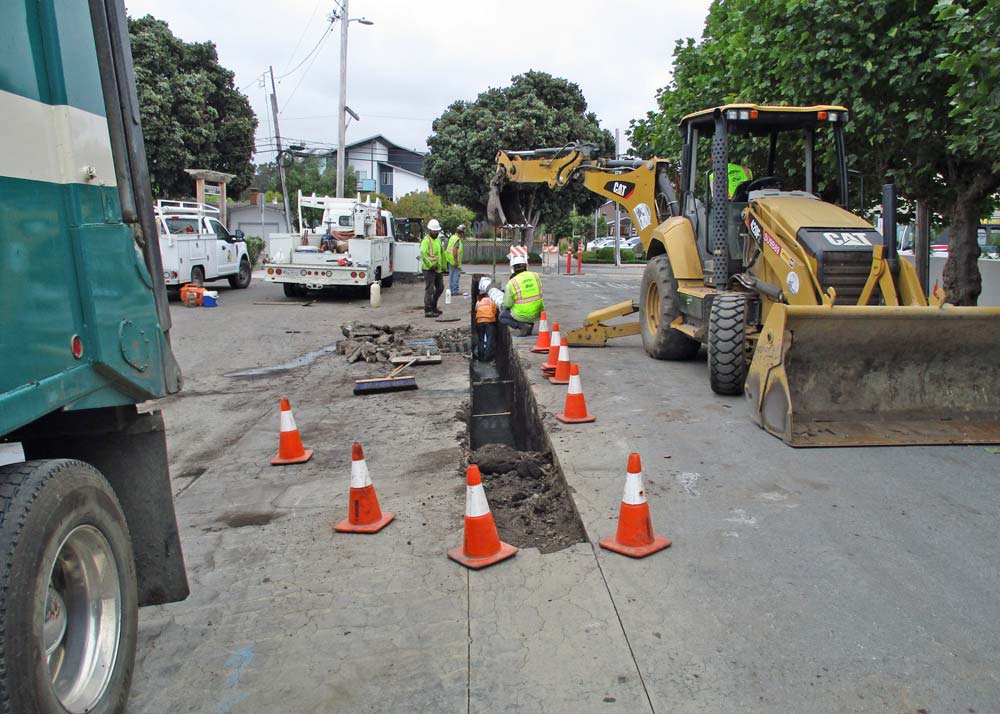

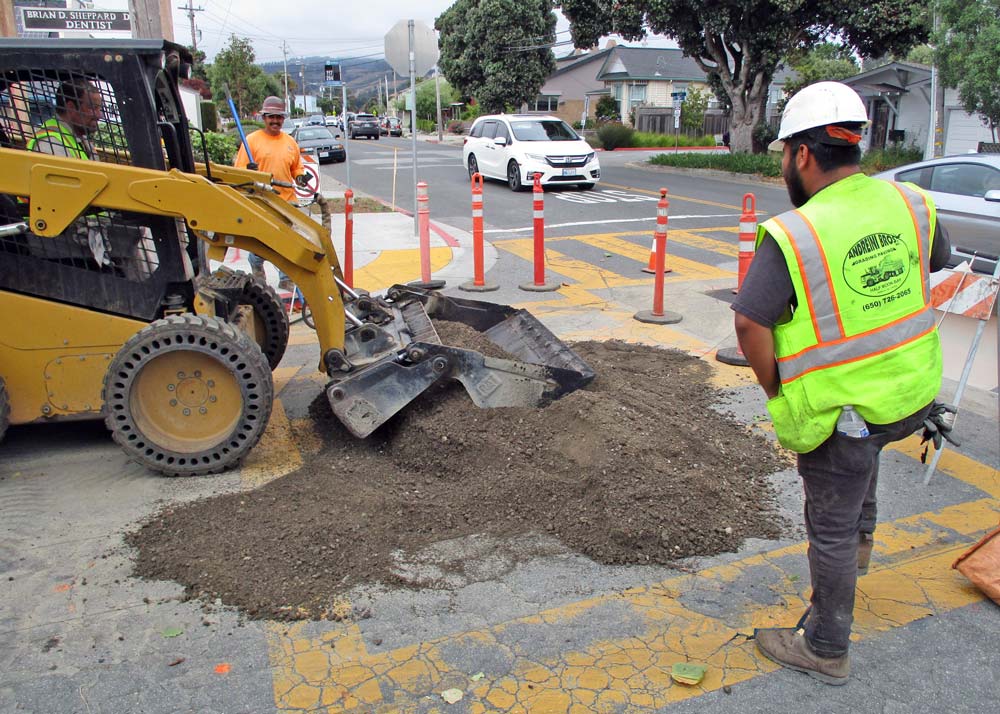

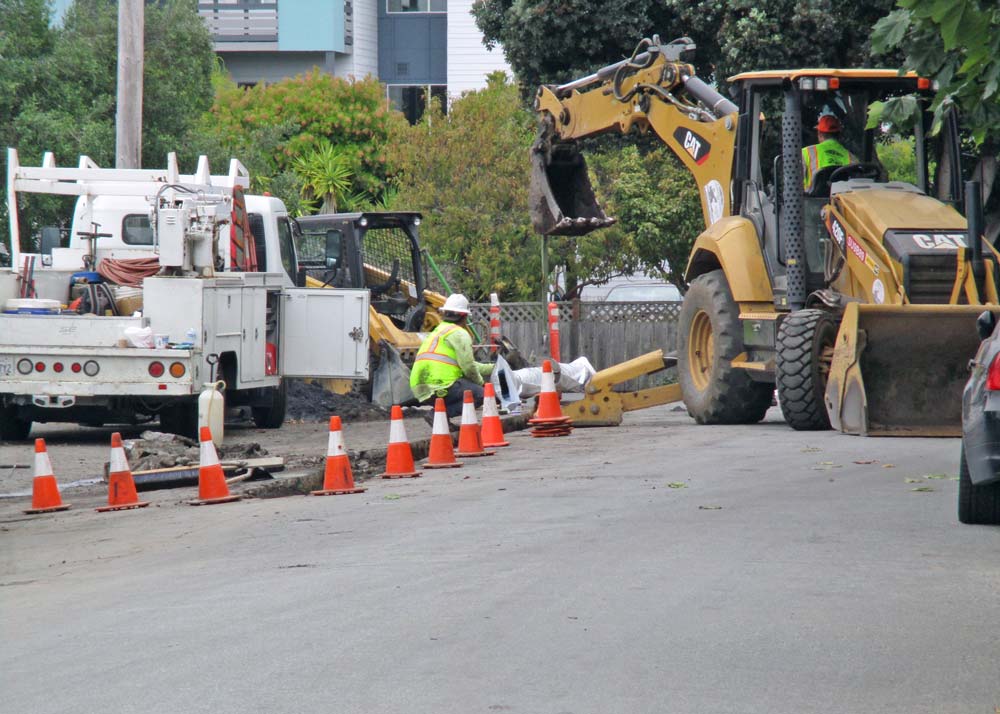

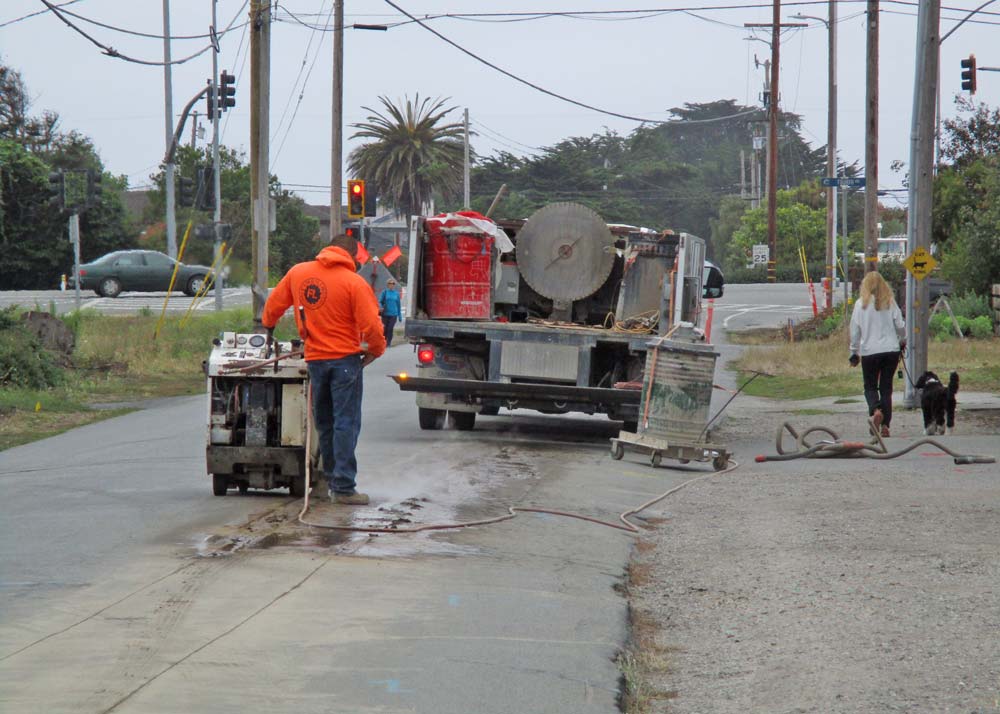

      Prior to the commencement of the City of Half Moon Bay’s Poplar Street Traffic Calming and Safety Project, CCWD replaced 850 feet of existing cast iron main with new ductile iron pipe, domestic services and operating valves adjusted to the new street profile.

      Future Projects

      • Scheduled to start Spring 2026:

        Scheduled Pipeline Replacements

        PROJECT ESTIMATED COST: $1,000,000+
      • Scheduled to start Summer 2026:

        Pilarcitos Canyon Road Repairs

        PROJECT ESTIMATED COST: $400,000

      Major Projects Completed in the Last 5 Years

      • July 2025

        Highway 92 Pipeline Replacement Project Phase 1

        PROJECT COST: $3,000,000
      • July 2024

        Magellan/Highway 1 and Alameda Avenue Pipeline Restoration Projects

        PROJECT COST: $500,000
      • June 2024

        Nunes Water Treatment Plant Improvement Project

        PROJECT COST: $10,450,000
      • June 2024

        Valve Replacement Project

        PROJECT COST: $300,000
      • February 2024

        Poplar Street Water Main Replacement Project

        PROJECT COST: $416,000
      • June 2023

        Grandview Water Main Replacement Project

        PROJECT COST: $1,900,000
      • February 2023
        Pipe Under Creek-Pilarcitos-Strawflower
        PROJECT COST: $700,000
      • January 2023
        Crystal Springs Pump Replacement Project
        PROJECT COST: $300,000
      • June 2022
        Nunes Fuel Tank Upgrade Project
        PROJECT COST: $200,000
      • June 2021
        Denniston Water Treatment Plant and Booster Pumpstation Emergency Power/Generator Project
        PROJECT COST: $600,000
      • August 2020
        Denniston Water Treatment Plant/Denniston Tank Road Repairs
        PROJECT COST: $500,000
      • June 2020
        Ferdinand Avenue Pipeline Replacement Project
        PROJECT COST: $650,000
      • May 2020
        Pilarcitos Canyon Pipeline Replacement Project
        PROJECT COST: $1,400,000
      • February 2020
        Casa Del Mar & Grand Avenue PRV and Pipeline Replacement Project
        PROJECT COST: $650,000
